You can use a centralized or decentralized deployment. You need to understand the architecture and technical options.
The first release of Rapid Planning was a patch on top of release 12.1.1. The first official eBusiness Suite release containing Rapid Planning is 12.1.3.
Oracle Rapid Planning works with:
Other Oracle Value Chain Planning products (destination) including Oracle Demantra
Oracle E-Business Suite execution (source) products
Oracle JD Edwards EnterpriseOne execution (source) products
Third-party execution (source) systems
To find out the source and destination releases that work together, see Oracle Rapid Planning Release Notes. Navigate to Oracle E-Business Suite Documentation Web Library, Release 12.1 or Release 12.2. Click tab VCP and navigate to region Value Chain Planning Release Notes.
If the release notes say that certain versions of source and destination systems work together, it means that:
Rapid Planning works in that configuration
Collections to Rapid Planning works in that configuration

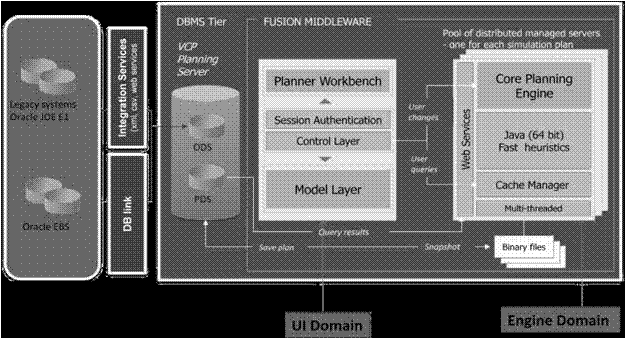

This graphic shows the Rapid Planning engine.
You deploy Rapid Planning in two domains of the WebLogic Server:
User interface: ADF components, for example faces and business components.
Engine: Multiple managed servers that you can scale to handle as many plans as you need.
They communicate using web services.
Rapid Planning stores completed plans as binary files in the WebLogic Server. When you close a plan, the binary files remain. When you re-open a plan, Rapid Planning loads the data into the user interface.
You request Rapid Planning to save completed plans to the database. Use the Save Plan action.
When you save the plan, Rapid Planning selectively flushes records into the database. For example, it flushes the records from the Supply/Demand view that display in the view to table msc_supplies. The Cache Manager of the Rapid Planning solver eliminates duplicates in the database.
Rapid Planning uses the same base tables as Advanced Supply Chain Planning.
It does not use all of the tables that Advanced Planning uses.
There are Rapid Planning-specific columns in some tables, for example, those that Clear to build and Demand Pull-in use.
While you perform Rapid Planning simulations, the plan data is in memory and not available in the base tables.
Updates that you make in the Rapid Planning UI, for example, demand priorities and demand due dates, go into memory as well.
Once you save a plan:
Rapid Planning flushes the simulation data, for example, updates, planned orders, and exceptions, into the base tables.
You can query it
The data flow of regenerative plans or plans run with snapshot is similar to Advanced Supply Chain Planning.
The Plan ID is the reference for which data belongs to which plan. Records have Plan ID after you save the plan.
See Oracle Value Chain Planning Collections Implementation Guide, Architecture.
To find patches, installation instructions, and an upgrade matrix, see MyOracleSupport note 746824.1: 12.x - Latest Patches and Installation Requirements for Value Chain Planning (aka APS Advanced Planning & Scheduling).
This table shows the Oracle Rapid Planning profile options.
Profile Name | Default Value | Values | Description |
---|---|---|---|
MSC: Rapid Planning Consume Forecast with No Demand Class | Null | Within Each Bucket, After Consuming Demand Class Specific Forecast, Null | This profile option specifies the order that the forecast consumption process should use to consume forecast entries when some of them have a demand class and some of them do not have a demand class. Valid values are:- Within Each Bucket: Consume forecast entries for the day on the sales order; it consumes entries with matching demand class first, then entries with no demand class. Then, it consumes forecast entries within the backward and forward consumption days; for each day, it uses matching demand class first, then no demand class- After Consuming Demand Class Specific Forecast: The forecast consumption process starts by consuming forecast entries for the day on the sales order with matching demand class only. Then, it consumes forecast entries within the backward and forward consumption days with matching demand class only. If there is a remaining sales order quantity, it repeats the process against forecast entries with no demand class, first on the day on the sales order, then within the backward and forward consumption days. |
MSC: Rapid Planning Group Planned Orders | None | None, Demand Level, Item Level | Determines if the planning solver groups planned orders of the same type. It:
Valid values are:
|
MSC: Sourcing Variance Tolerance | 0.05 | Positive number <= 1 | Use this profile option to specify the tolerance that you allow between sourcing percentages and the actual percentages in a split sourcing window. If the difference is outside the tolerance, the planning solver issues exception message Sourcing split percentage violated. |
MSO: Sourcing Allocation Window | 7 | Positive integer | Use this profile option to divide the planning horizon in to windows. In each window, the planning solver plans to meet the split sourcing percentages. |
Rapid Planning Weblogic Server Home | Null | For example,
/slot/xyz/abc/WLS/11gNN/WLS_Home |
The path of the Oracle Rapid Planning Weblogic server home. |
Released WIP Jobs: Consider in Clear to Build | No | Yes/No | Use this profile option to instruct the planning solver whether to calculate clear to build for released discrete jobs. Valid values are:
|
Safety Stock Lead Time Method | Safety Stock Percent | Do not compute safety stock, Use Safety Stock Percent, Use Safety Stock Quantity | Use when you want to calculate safety stock by quantity.
Note: The Safety Stock Method is set to MRP PLANNED PERCENT. |
Oracle Rapid Planning uses the MSC: profile options that you set on the Plan Options > Advanced tab. See Plan Options.
The planning solver uses these technical profile options. These are not included in the Plan Options > Advanced tab:
MSC: 64 Bit Planner Platform
MSC: Debug Mode
MSC: Enable 64 Bit snapshot
MSC: Hour UOM
MSC: Snapshot Workers
MSC: Wait Time to Obtain Lock on Table or Partition for Snapshot Delete Worker (seconds)
These are other profile options that the planning solver uses. See Oracle Advanced Supply Chain Planning Implementation and User's Guide:
MRP: Plan Revenue Discount Percent
MRP: Plan Revenue Price List
MSO: Inventory Carrying Costs Percentage
