Working with Risk Iteration Analysis Results

This topic provides examples of schedule risk analysis results as well as integrated cost and schedule risk analysis results.

For a complete list of columns that we recommend you display while analyzing either type of results, review the table at the end of this topic.

Schedule Risk Analysis Results

This screenshot depicts impacted dates and schedule data, represented by a grid on the left and a Gantt chart on the right.

Risk Iteration Analysis - Schedule

In a risk analysis, deterministic values are the values for the activity at the time that the risk analysis was run.

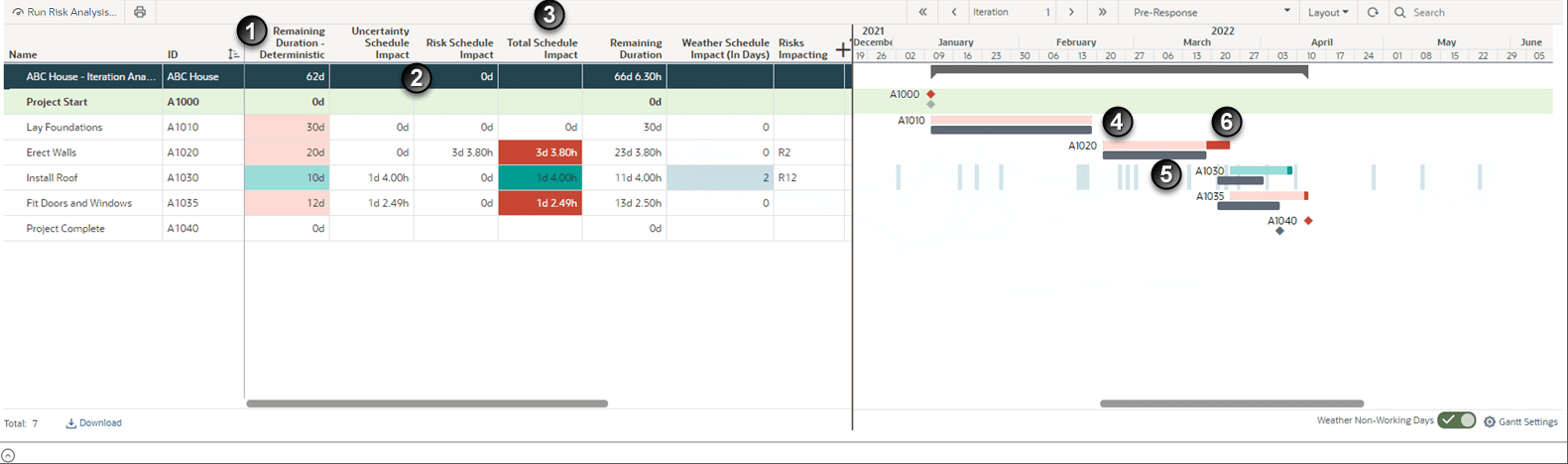

Table of Screen Highlights

Item

Description

1

Remaining Duration - Deterministic: This field represents the remaining duration for the activity at the time the risk analysis was run. This is the value that is impacted by risk and uncertainty in each iteration.

2

Uncertainty Schedule Impact and Risk Schedule Impact: These fields display the potential impact to the duration of the activity because of uncertainty or risk.

3

Total Schedule Impact: This field is the difference between the Iteration Remaining Duration and the Remaining Duration – Deterministic.

In many cases, the Total Schedule Impact is the sum of the Uncertainty Schedule Impact and the Risk Schedule Impact for the iteration.

In some cases, there can be an Indirect Schedule Impact, that is a variation between deterministic remaining duration and iteration remaining duration that is not due to risk or duration uncertainty. This can include Resource Dependent Activities where the Resource Calendar and Activity Calendars are different. It is always the case for WBS Summary and Level of Effort Activities.

If you were to visualize these fields as calculations, they would look like:

  • Total Schedule Impact = Iteration Remaining Duration – Deterministic Remaining Duration
  • Total Schedule Impact = Uncertainty Schedule Impact + Risk Schedule Impact (for most activities)
  • Total Schedule Impact = Uncertainty Schedule Impact + Risk Schedule Impact + Indirect Schedule Impact

Note: Indirect Schedule Impact can occur for Resource Dependent Activities where the Resource Calendar and Activity Calendar are different. For WBS Summary and Level of Effort Activities, the Schedule Impact will always be Indirect.

4

Colored Bars: The Remaining Duration - Deterministic, Total Schedule Impact, and Iteration Remaining Duration values are represented by colored bars on the Gantt chart. Above the activity's gray bar, the Remaining Duration for the iteration is displayed as a red bar (for critical activities) or a green bar (for non-critical activities).

5

Gray Bars: The gray bars for the activity are drawn between the activity's Deterministic Start Date and Deterministic Finish Date.

6

Dark Green / Dark Red Bars: The Total Schedule Impact on the Remaining Duration bar is the darker red or green portion of the bar. The Remaining Duration - Deterministic and Total Schedule Impact columns are also highlighted in red or green to match the Gantt bars.

7

Project Risk Impacts Bar: This bar in the Project Risk Impacts row displays project impacts due to risks that are not assigned to an activity.

8

Details Panel: View Risk Impacts, Relationships, and Resource Assignments affecting the iteration.

Note: If you would like an additional way to view if an activity is critical other than the column and Gantt bar colors, add the Critical - Deterministic and Critical columns to the grid.

For example, for the Install Roof activity in the screenshot, the columns and Gantt bar are green because it is not a critical activity. The total length of the bar represents the Iteration Remaining Duration for the risk analysis iteration currently displayed. The lighter green represents the Remaining Duration - Deterministic amount and the dark green portion is the additional time from the Total Schedule Impact.

Integrated Cost & Schedule Risk Analysis

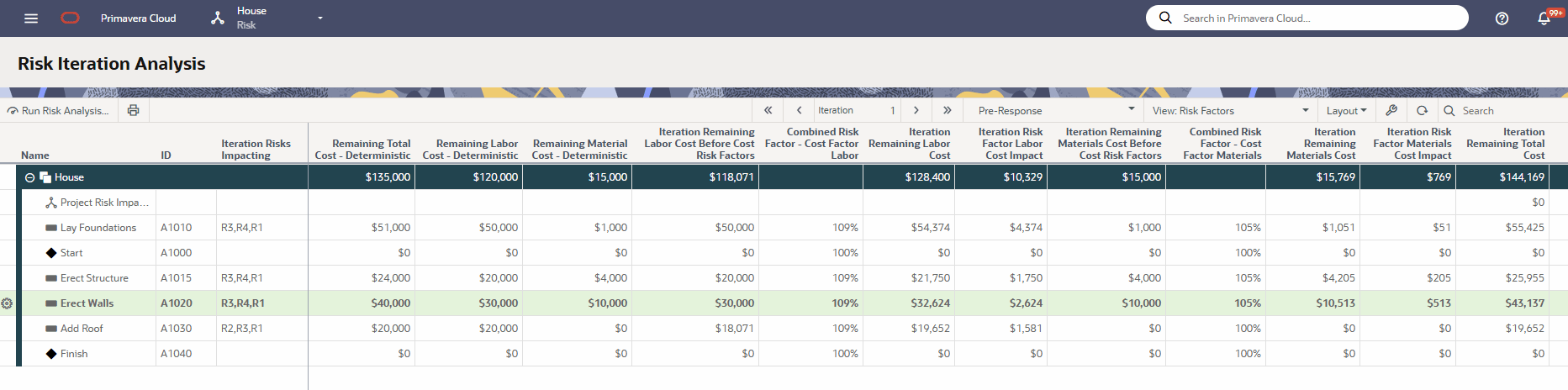

In this screenshot, the risk iteration analysis displays a combination of impacted cost and schedule data.

Risk Iteration Analysis Schedule and Cost

Tips for reviewing the results

If you were to visualize these fields as calculations, they would look like:

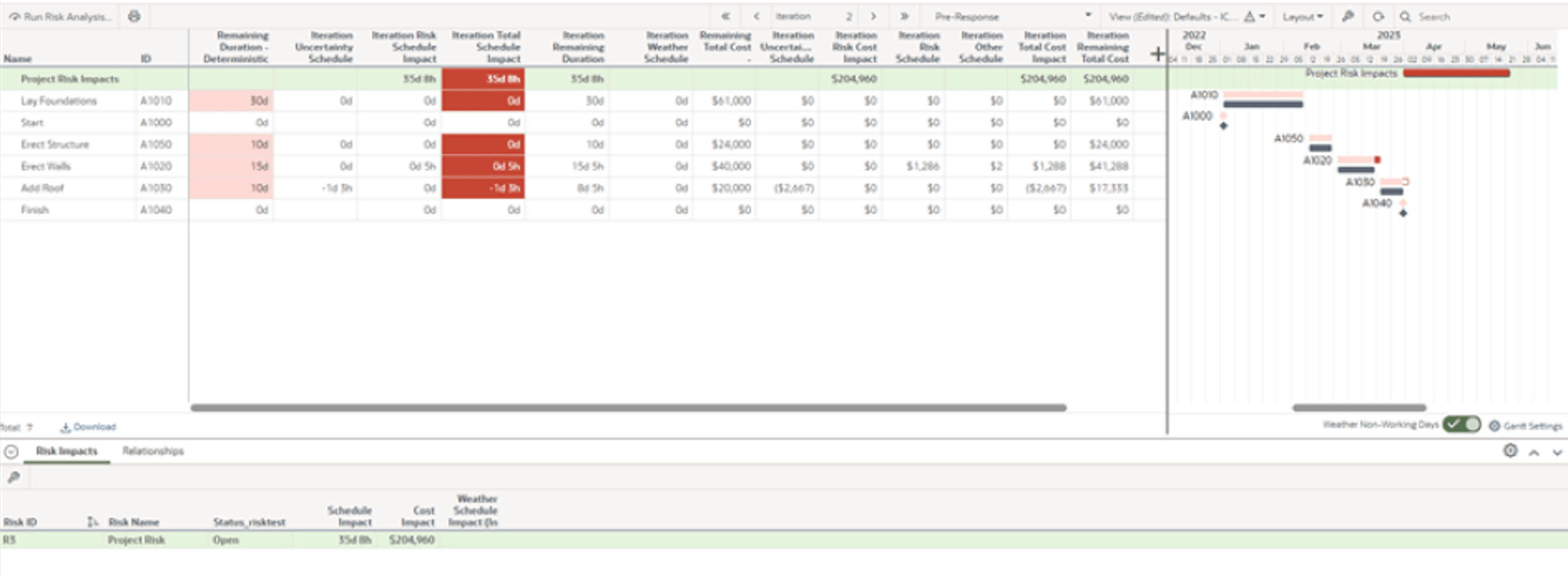

Any Risks that are not assigned to an activity can still impact the project. The Schedule Impact is simply added onto the Project Schedule Finish Date for that iteration. This can be seen in the Project Risk Impacts Bar. Any cost impacts from risks are also included in the Iteration Remaining Total Cost for the Project Row. Note that risks that are not assigned to an activity can not have a resulting cost increase due to schedule impact. This screenshot displays an example of a Project Risk Impacts Bar, shown as the top row of the grid view and as the red bar in the Gantt chart.

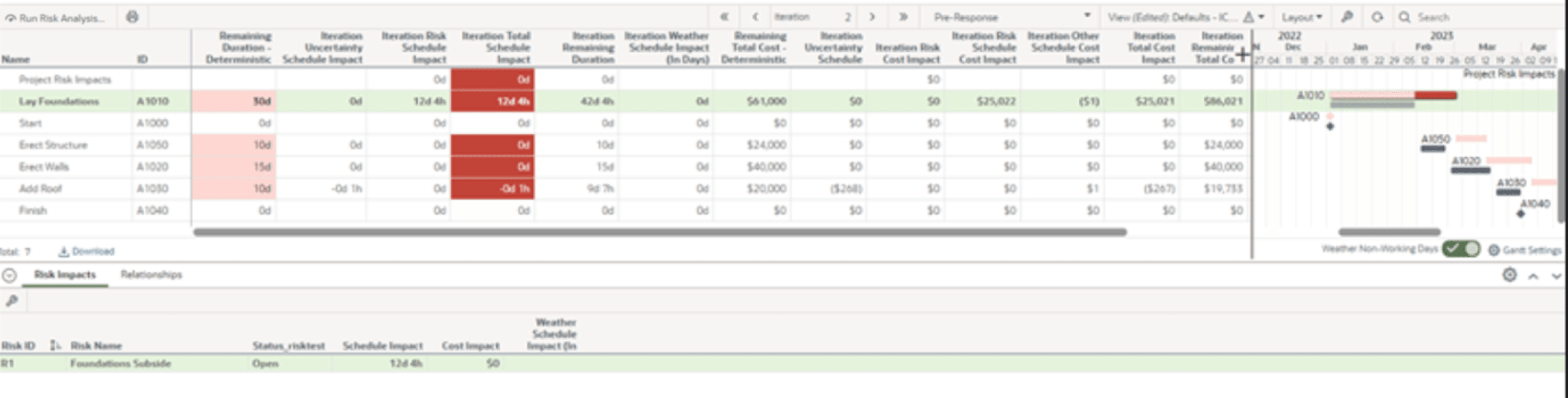

This is a screenshot illustrating the Project Row Iteration Bar. This is explained in the text.

Recommended Risk Iteration Analysis Fields

Field Name

Field Description

Schedule Risk Analysis

Integrated Cost & Schedule Risk Analysis

Remaining Duration - Deterministic

The activity remaining duration at the time the risk analysis was run.

X

X

Iteration Uncertainty Schedule Impact

For the iteration, the difference between the activity deterministic remaining duration and the duration sampled from the activity Uncertainty Distribution. The value can be positive or negative. Stored for the first 50 iterations only.

X

X

Iteration Risk Schedule Impact

The change in the activity remaining duration due to risks impacting the activity for the iteration. Only schedule impacts from Threats and Opportunities are included (Weather risks impact an activity's non-working, but not the remaining duration). If the sampled risk schedule impacts on the activity are greater than the activity remaining duration, then the activity remaining duration is set to 1 minute because negative duration values are not supported. Stored for the first 50 iterations only.

X

X

Iteration Indirect Schedule Impact

Variation between deterministic remaining duration and iteration remaining duration that is not due to risk or duration uncertainty. Stored for the first 50 iterations only.

X

X

Iteration Total Schedule Impact

The Total Schedule Impact is the difference between the Iteration Remaining Duration and the Remaining Duration – Deterministic. Stored for the first 50 iterations only.

X

X

Iteration Remaining Duration

The activity remaining duration for the iteration. Stored for all iterations.

X

X

Iteration Weather Schedule Impact (In Days)

The number of weather non-working days between the start and finish of the activity for the iteration. Weather non-working time that coincides with other non-working weather time on the activity time is included. Stored for the first 50 iterations only.

X

X

Risks Impacting

The risks that impacted the activity for the iteration. Stored for the first 50 iterations only.

X

X

Remaining Total Cost - Deterministic

The activity remaining total cost at the time the risk analysis was run.

X

Iteration Uncertainty Schedule Cost Impact

Total cost impact due to uncertainty on the activity for the iteration. Stored for the first 50 iterations only.

X

Iteration Risk Cost Impact

The total for the iteration of the cost impact on the activity due to risks impacting the activity. Stored for the first 50 iterations only.

X

Iteration Risk Schedule Cost Impact

Activity cost increase due to the schedule impacts from threats and opportunities. Stored for the first 50 iterations only.

X

Iteration Other Schedule Cost Impact

Other cost impact on the activity for the iteration. Stored for the first 50 iterations only.

X

Iteration Total Cost Impact

Total cost impact due to risks on the activity for the iteration. Stored for the first 50 iterations only.

X

Iteration Remaining Total Cost

The activity remaining total cost for the iteration. Stored for all iterations.

X

Start - Deterministic

The activity start date at the time the risk analysis was run.

Note: this is included to allow default sorting by Start Date.

X
