Reserve Component Items for Work Orders

You can now manually reserve component items for work orders by invoking the material reservations action for a job operation from Work Content or Dispatch List in Oracle MES for Discrete Manufacturing. Additionally, the component availability program  is enhanced to create, update, or delete high level component item reservations for multiple work orders automatically. This enables you to create or update component reservations for multiple work orders along with the component availability calculations in MES.

Run the Component Availability Program:

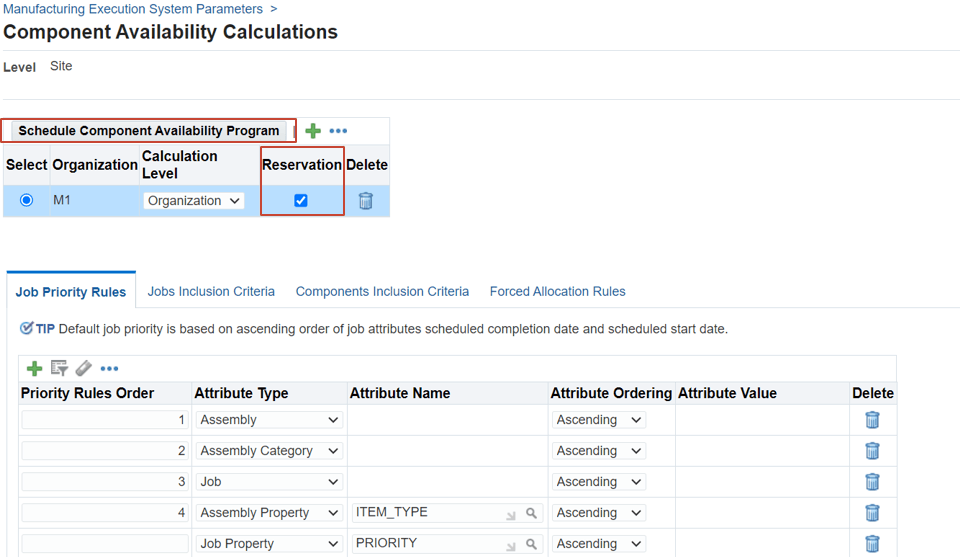

Run the Component Availability Program

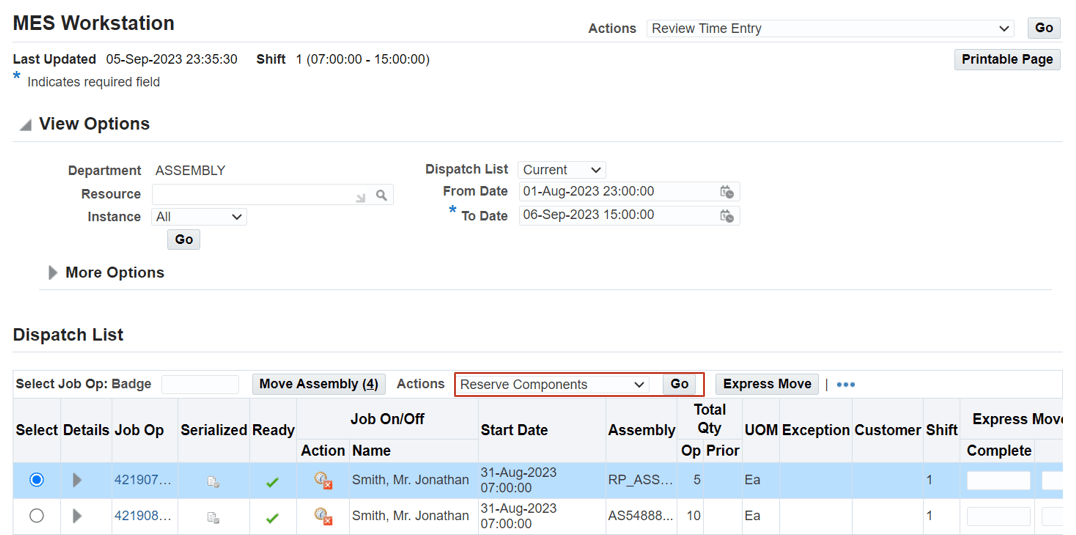

Reserve components on the MES Workstation's Dispatch List:
Reserve components on the MES Workstation's Dispatch List

Reserve components on the MES Workstation's Work Content:
Reserve components on the MES Workstation's Work Content

Reserve components on the MES Supervisor's Dispatch List:
Reserve components on the MES Supervisor's Dispatch List

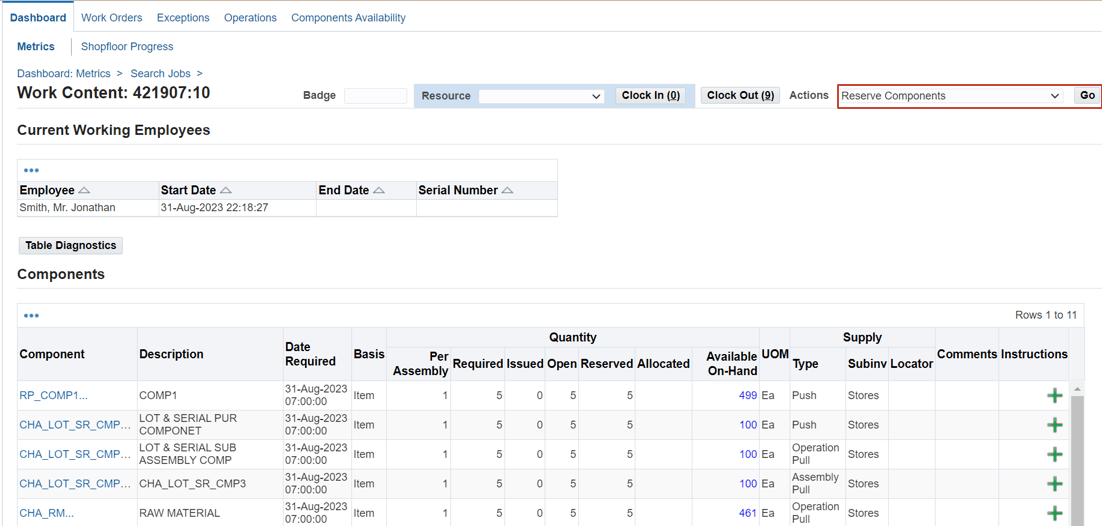

Reserve components on the MES Supervisor's Work Content:
Reserve components on the MES Workstation's Work Content

Prior to this release, supervisors had less direct access to component reservation action from the MES job operation context.

The ability to manually reserve component items for work orders helps supervisors with accurate and timely shop floor execution across distributed production environments while preserving traceability, labor visibility, and transaction control.

The enhanced component availability program enables you to create or update component reservations for multiple work orders along with the component availability calculations in MES for Discrete Manufacturing.

Steps to enable and configure

Ensure the following set up steps to manually reserve component items for work orders:

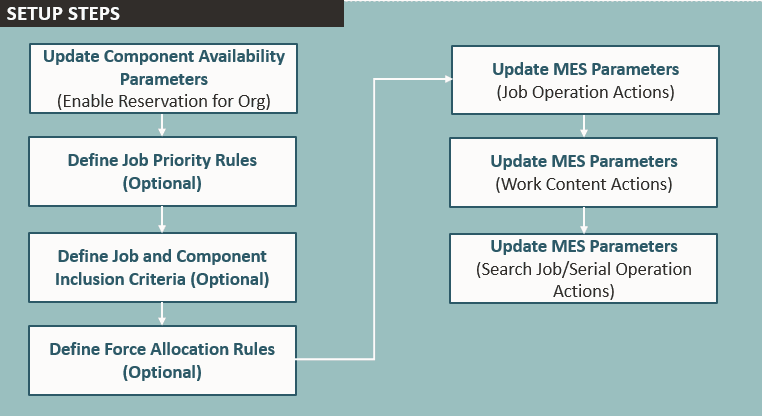

Setup to manually reserve component items for work orders:

Tips and considerations

  • Enable Reservation at organization level to automatically reserve items for multiple work orders.
  • The program reserves material for multiple work orders as well as component availability based on Job priority rules, job and component inclusion criteria, and forced allocation rules.
  • By default, the program uses job priority based on ascending order of job scheduled completion date and job scheduled start date.
  • If components are already reserved for work orders through WIP, the high-level reservations are created or updated when the component availability program is run in MES.

Key resources
