Key Milestones Tracking Dashboard

Description: This project gives an Executive / PMO insights to track key milestones for projects/portfolios and identify variance over time. It can be used to track milestone activities based on the variance status that is ahead, on, or behind schedule. These activities can also be traced based on their activity status.

Number of Canvases: 2

Default Canvas: Key Milestones

Canvas/Dashboard Name: Key Milestones Tracking

Data Source(s): P6 EPPM

Subject Areas: P6 – Activity

Datasets: Not applicable

Canvases

Figure 4-5 Key Milestones


Key Milestones

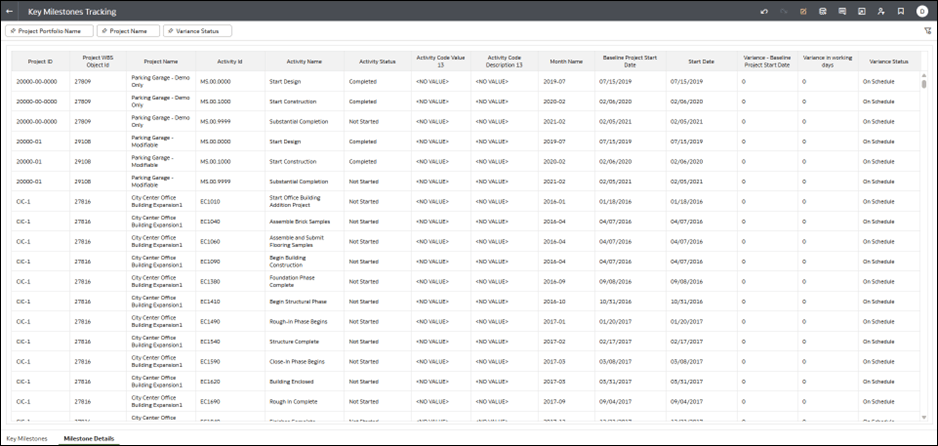

Figure 4-6 Milestone Details


Milestone Details

Table 13: Key Milestones Tracking- Dimensions

Canvas Dimension Name Dimension / Attribute Subject Area / Dataset
Key Milestones Calendar Month Name P6 - Activity
Key Milestones Activity Activity Status P6 - Activity
Key Milestones Project Project Id P6 - Activity
Key Milestones Project Unique Project WBS ID P6 - Activity
Key Milestones Project Project Name P6 - Activity
Key Milestones Activity Activity ID P6 - Activity
Key Milestones Activity Activity Name P6 - Activity
Key Milestones Activity Key Milestones Value P6 - Activity
Key Milestones Activity Key Milestones Description P6 - Activity
Key Milestones Activity Baseline Project Start P6 - Activity
Key Milestones Activity Start P6 - Activity
Key Milestones Activity Variance Baseline Project Start Date P6 - Activity

Table 14: Key Milestones Tracking- Custom Dimensions

Dimension Expression Source Subject Area / Dataset
Variance in working days "Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date"/8 Derived from Dimension P6 - Activity
Variance Status CASE WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 > 0 THEN 'Ahead' WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 < 0 THEN 'Behind' WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 = 0 THEN 'On Schedule' ELSE '' END Derived from Dimension P6 - Activity

Table 15: Key Milestones Tracking - Measures

Canvas Fact / Measure Measure Type Subject Area / Dataset
Key Milestones # of Activities Fact P6 - Activity

Table 16: Key Milestones Tracking - Calculated Members

Calculated Member Expression Source Subject Area / Dataset
% of activities behind schedule (FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 < 0))/"Primavera - Activity"."Metrics"."# of Activities" Derived From Fact P6 - Activity
% of activities on schedule (FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 = 0))/"Primavera - Activity"."Metrics"."# of Activities" Derived From Fact P6 - Activity
% of activities ahead of schedule (FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 > 0))/"Primavera - Activity"."Metrics"."# of Activities" Derived From Fact P6 - Activity

Table 17: Key Milestones Tracking - Filters

Canvas Filter Type Is Expression Filter Dimension / Attribute / Measure Subject Area / Dataset
Key Milestones Visualization No Activity Type P6 - Activity
Key Milestones Dashboard No Variance Status P6 - Activity
Key Milestones Dashboard No Project Name P6 - Activity
Key Milestones Dashboard No Portfolio Name P6 - Activity

Table 18: Key Milestones Tracking - Data Actions

Data Action Name Action Type Anchor To Target Canvas Link Pass Values Multiselection
Navigate to Milestone details Analytics Link None Key Milestones Tracking Milestone Details All On
P6 Link to Activities URL Navigation Project Name Opens P6 Links - Link to Activities Milestone Details All On
