Interim Completion of Construction Work Activity
Currently the details of installation, removal, service histories and measurements recorded by a field worker are only sent from OFSC to WAM when an activity is completed in OFSC. For an activity that requires more than one day of work (multi-day activity) and so has multiple segments in OFSC, the details are only sent from OFSC to WAM when all segments have been completed.
Interim completion will allow the details of installation, removal, service histories and measurements to be sent from OFSC to WAM when an individual segment is completed. For this release only, it is applicable to Construction Work Activities.
Some of the key points related to Interim Activity Completion:
1. Planned Service Histories and Service Histories that have been sent to WACS/WAM in previous segments are available in View mode only. They cannot be edited.

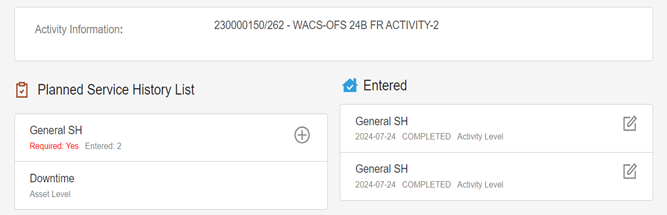

Previous Segment

Latest Segment

2. Measurements that have been sent to WACS/WAM in previous segments are available in View mode only. They cannot be edited.

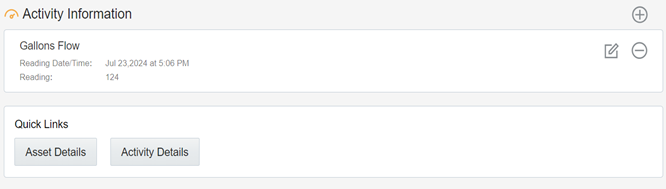

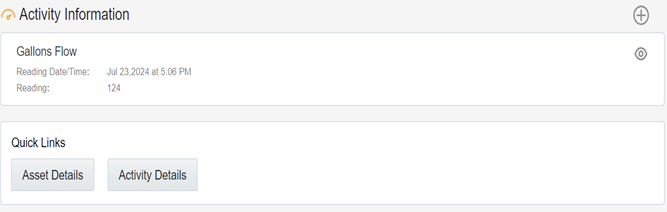

Previous Segment

Latest Segment

3. Percent Complete in WACS/WAM shows how much percentage the activity is completed.

4. Undo option will not be available for operations (installation, removal, material usage) once details have been sent to WACS/WAM in previous segments.
5. For Update Quantity task, quantity completed will be sent to WACS/WAM in each segment’s interim completion, not when all segments have been completed.
Note: For Interim Activity Completion, do not start the successor segments of activity until either previous segments details are sent to WACS/WAM or completion flow errors out for previous segments.
