6.5.4 Shock Types for Variables
Shock Type for numeric variables
If you have selected numeric type of variable select from one of the shock type and provide your inputs.Note:
For MEVTS variables, only the following shock types are applicable:- Absolute Values
- Constant Absolute Growth per Annum
- Constant Growth in Percentage per Annum
- Absolute Value - the formula to calculate
this is:
Where,
Input Value is the value entered on the User Interface (UI).
- Absolute Growth on Current value (AGC) - the
formula to calculate this is:
Where,
Current Value - is the reference value entered on the UI
Input Grid Value - percentage or absolute value you enter by which you want to increase or decrease the current value of reference date.
- Absolute Growth on Future value (AGF) - the
formula to calculate this is:
Where,
*For each iteration the Current Value is updated based on the previous calculation.
Current Value - is the reference value entered on the UI
Input Grid Value - is the percentage or absolute value you enter by which you want to increase or decrease the current value of reference date.

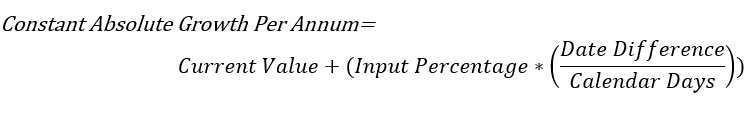

- Constant Absolute Growth Per Annum (CAGPA) -
the formula to calculate this is:
Where,
Current Value - is the reference value entered on the UI
Input Percentage - is the percentage value of growth or deprecation
Date Difference - is the frequency selected.

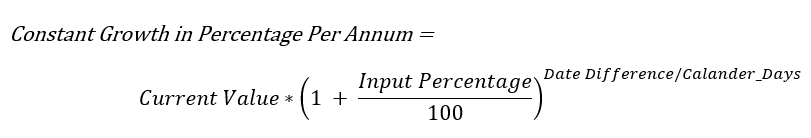

- Constant Growth in Percentage Per Annum
(CGPPA) - the formula to calculate this is:
Where,
Current Value - is the value entered on the UI.
Input Percentage - is the percentage value of growth or deprecation
Date Difference - is the frequency for the calculations

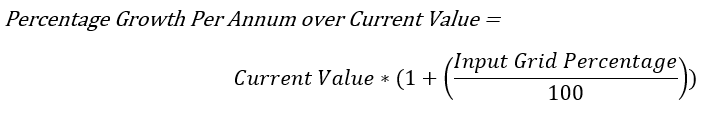

- Percentage Growth Per Annum over Current Value
(PGPAC) - the formula to calculate this is:
Where,
Current Value - is the value entered on the UI.
Input Grid Percentage - is the percentage you enter by which you want to increase or decrease the current value of reference date.

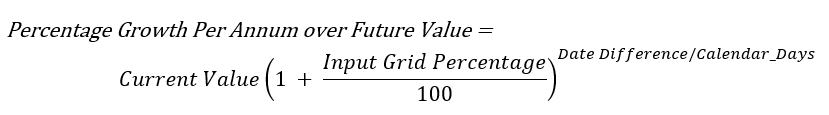

- Percentage Growth Per Annum over Future value
(PGPAF) - the formula to calculate this is:
Where,
*For each iteration the Current Value is updated based on the previous calculation
Input Grid Percentage - is the change per annum
Data Difference - is the difference between the frequency of dates mentioned
Examples of Shock Types
Below is a list of examples for all the shock types with details:
For example, you enter the following values in the Time Horizon Details section of the scenario wizard:
Frequency: monthly
Time Frame: 2
Reference Date: 21/May/2024
Start Date: 31/May/2024
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the current value and the absolute values for the variables on 31st may and 30th June as
10, 50
and10
.
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the current value and the absolute values for the variables on 31st may and 30th June as
10, 50
and10
. - When you click Compute input values, then the growth on the absolute values for 31st may and 30th June are
60
and20
.Since,- Absolute Growth on Current value on
31/May/2024
(60) = Current Value (10) + Input Value on31/May/2024
(50) - Absolute Growth on Current value on
30/June/2024
(20) = Current Value (10) + Input Value on30/June/2024
(10)
- Absolute Growth on Current value on
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the current value and the absolute values for the variables on 31st May and 30th June as
10, 50
and10
. - When you click Compute input values, then the growth on the absolute values for 31st May and 30th June are
60
and70
.Since,- Absolute Growth on future value on
31/May/2024
(60) = Current Value (10) + Absolute Value (or Input Value) on31/May/2024
(50) - Absolute Growth on future value on
30/June/2024
(70) = Current Value (60) + Absolute Value (or Input Value) on30/June/2024
(10)
- Absolute Growth on future value on
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the Absolute value or Constant Absolute Value(FOR ALL DATES) percentage as
50%
and the Current Value as10
. - When you click Compute input values, then the absolute growth for 31st May and 30th June are
11.3889
and15.5556
.Since,DDC1: Date Difference From Current Value (D1-D0)=10
DDC2: Date Difference From Current Value(D2-D0)=40
- Constant Absolute Growth Per Annum on
31/May/2024
(11.3889) = 10 +(50*(10/360)) - Constant Absolute Growth Per Annum on
30/June/2024
(15.5556) = 10+(50*(40/360))
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the percentage or the Constant Percentage Value as
50%
and current value as10
. - When you click Compute input values, then the growth rate on 31st May and 30th June are
10.1133
and10.4608
.Since,DDC1: Date Difference From Current Value (D1-D0)=10
DDC2: Date Difference From Current Value(D2-D0)=40
- Constant growth in percentage per annum on
31/May/2024
(10.1133) = 10*(1+(50/100))(10/360) - Constant growth in percentage per annum on
30/June/2024
(10.4608) = 10*(1+(50/100))(40/360)
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the current value and the growth over current value percentages on 31st may and 30th June as
10, 50%
and10%
. - When you click Compute input values, then the growth rate on 31st May and 30th June are
10.1133
and10.1065
.Since,DDC1: Date Difference From Current Value (D1-D0)=10
DDC2: Date Difference From Current Value(D2-D0)=40
- Percentage Growth per annum over future value on
31/May/2024
= 10*(1+50/100)(10/360) - Percentage Growth per annum over future value on
30/June/2024
= 10*(1+10/100)(40/360)
- The start date is displayed as part of the first sequence that is
31/May/2024
and the next date is calculated based on the frequency type (in this case, monthly or 30 days difference). Hence, the next date is30/June/2024
. - In this case, you can define the current and the growth over future percentages on 31st may and 30th June as
10, 50%
and10%
. - When you click Compute input values, then the growth rate on 31st May and 30th June are
10.1133
and10.1939
.Since,- Overall Percentage Growth over current value on
31/May/2024
= 10*(1+(50/100)) - Overall Percentage Growth over current value on
30/June/2024
= 10*(1+(10/100))
- Overall Percentage Growth over current value on
Categorical Shock Type
- Change of Class - based on the frequency entered you can select the value for this variable from the existing values
- Constant Notch Up/Down on Current Value - based on the current value, the variable value is increased or decreased by a notch.
- Constant Notch Up/Down on Future Value - based on the value entered, the next value that is the future value is calculated by increasing or decreasing the value by a notch (or by one value).
- Notch Up/Notch Down on Current Value - based on the current value, the variable value is increased or decreased by a notch (or by one value).
- Notch Up/Notch Down on Future Value - based on the value entered, the next value that is the future value is calculated by increasing or decreasing the value by a notch (or by one value).
- Universal
- When dimension is added to the selected variable- the grid maps each node in the dimension. Your input for each dimension node impacts all variable hierarchy nodes within that specific dimension node.
- When there are no dimensions in the selected variable - there is a single row of mapping for each variable hierarchy. Your input for that row affects all the nodes within the variable hierarchy.
- Local
- When dimension is added to the selected variable- the grid maps each node in the variable hierarchy to every node in the dimension.
- When there are no dimensions in the selected variable - the grid maps each node within the variable hierarchy individually.
Shock Type for MEVTS variable
This is a numerical variable with either a Micro or Macro subtype. Additionally, the tsBased flag is enabled, which allows the variable to capture its frequency, timeframe, and the start/end of the period during its creation.
Table 6-7 Scenario Grid Generation
Country | Observation Date | CV | 03-06-2025 | 03-07-2025 | 03-08-2025 |
---|---|---|---|---|---|
India | 30-04-2025 | 5% | 4.75% | 4.75% | 4.75% |
India | 31-07-2025 | 5% | 4.50% | 4.50% | 4.50% |
India | 31-10-2025 | 5% | 4.25% | 4.25% | 4.25% |
India | 31-01-2026 | 5% | 4.00% | 4.00% | 4.00% |
India | 30-04-2026 | 5% | 3.75% | 3.75% | 3.75% |
India | 31-07-2026 | 5% | 3.50% | 3.50% | 3.50% |
US | 30-04-2025 | 5% | 4.75% | 4.75% | 4.75% |
US | 31-07-2025 | 5% | 4.50% | 4.50% | 4.50% |
US | 31-10-2025 | 5% | 4.25% | 4.25% | 4.25% |
US | 31-01-2026 | 5% | 4.00% | 4.00% | 4.00% |
US | 30-04-2026 | 5% | 3.75% | 3.75% | 3.75% |
US | 31-07-2026 | 5% | 3.50% | 3.50% | 3.50% |
- Observation Date CalculationThe Observation Date column is unique to MEVTS variables and is calculated as follows:
- The first observation date is set as the scenario reference date.
- The total number of observation dates is equal to the variable's timeframe.
- The interval between observation dates is determined by the variable's frequency.
- The Start-of-Period / End-of-Period setting determines whether the observation dates align with the beginning or end of each period.
Shock Types for MEVTS Variables
Three types of shocks are supported:
- Absolute Values: Users manually input absolute values in
the scenario grid.
Figure 6-1 MVETS Absolute Values
- Constant Absolute Growth per Annum:
The formula and other configurations remain unchanged. However, in this case, the values are calculated based on observation dates corresponding to future periods. Minimum and maximum bounds are also applied for time series (TS)-based variables.
For example, if the user provides a current value of 5%, the calculation for the first future date (for example, 03/06/2025) will be based on the observation period from 30/04/2025 to 31/05/2025.
For the next future date (03/07/2025), the value from 03/06/2025 will be carried forward through interpolation, which, in this case, remains unchanged. As a result, the values across all future dates remain consistent, as shown in the scenario grid.

Figure 6-2 Constant Absolute Growth per Annum
Extrapolation Support
Users can enable extrapolation to extend observation dates beyond the current timeframe.- A new grid appears with extended future dates.
- The number of extra dates depends on the frequencies of the scenario and the variable.
Frequency Base Days:- Yearly (Y): 360 days
- Quarterly (Q): 90 days
- Monthly (M): 30 days
- Weekly (W): 7 days
- Daily (D): 1 day
The formula to calculate this is:
Figure 6-3 MVETS Variable formula
Example:
If the scenario frequency is Quarterly (90 days) and the variable frequency is Monthly (30 days):
Q/M = 90/30 = 3, therefore, 3 new dates are added per extrapolation step.
Extrapolated values are calculated using the same formula as defined for the selected shock type.

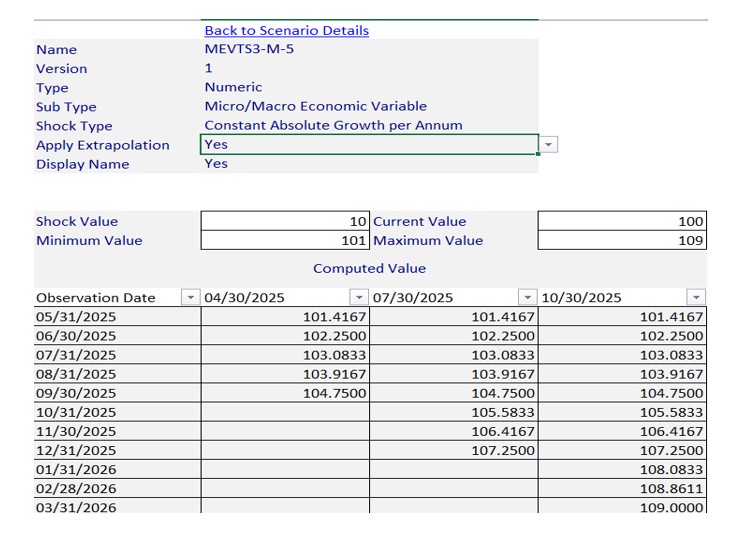

Figure 6-4 MVETS Variable Example
- Constant Growth in Percentage per Annum:
This type follows the same rules as the Constant Absolute Growth per Annum shock type, but uses a percentage-based growth formula.
Additional Information
- Interpolation (in Finance)
Used to estimate values within the range of known data points.
Example:
If a bond yields 4% for a 1-year maturity and 6% for a 3-year maturity, interpolation can estimate the 2-year yield.
- Extrapolation (in Finance)
Used to estimate values beyond the range of known data points based on trends.
Example:
If a stock grows 10% per year over 3 years, extrapolation can estimate its price in the next year, assuming the trend continues.
Shock Types for IRC Variables
If you have selected numeric type of variable select from one of the shock type and provide your inputs.- Absolute Value - the formula to calculate
this is:
Where,
Input Value is the value entered on the User Interface (UI).
- IRC Variable Grid Formation
During the variable creation process, terms and multipliers are defined for the IRC variable.
Users can then enter current values, and the system will calculate corresponding future date values.
The resulting grid appears as follows:

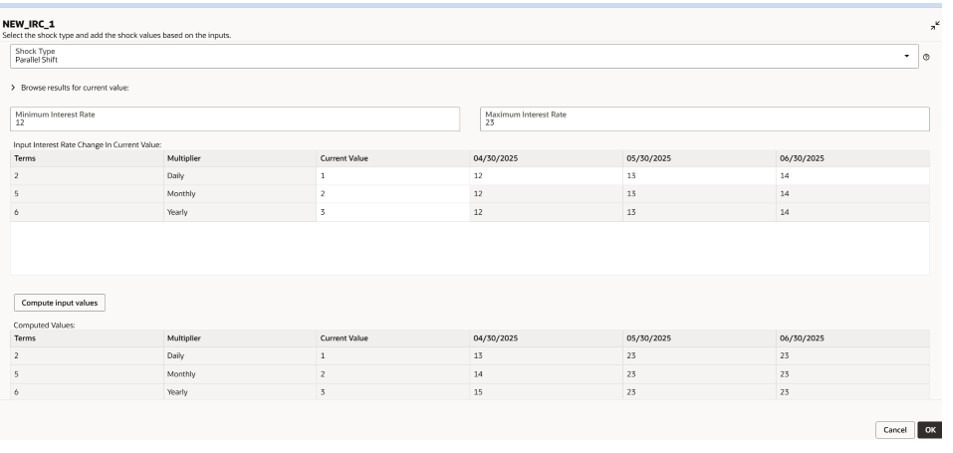

Figure 6-5 IRC Variable Grid Formation
IRC variable also has absolute value shocktype.
- Flat:: the formula to claculate this is as
follows:
Figure 6-6 IRC Variable Grid Formation
In this shock type, the user provides input only for the current value.
All future values remain unchanged, resulting in a flat curve with no variation across time.
- Parallel Shift: the formula to claculate this is as
follows:
Figure 6-7 Parallel Shift formula
The user may optionally specify minimum and maximum bound values.
A single delta value is entered for all future dates and is uniformly applied to the current values.
This results in a parallel shift of the entire curve.
