Oracle Project Procurement Command Center

This chapter describes Project Procurement Command Center and discusses how project managers can use the command center.

This chapter covers the following topics:

Project Procurement Command Center Overview

With Oracle Project Procurement Command Center project teams, project managers, and project buyers can establish and measure strategic project objectives and drive project procurement planning, decision-making, and execution throughout the project lifecycle. The command center brings together project and procurement information that is critical to aligning strategy with planning and execution.

Use the command center to:

The Project Procurement Command Center includes role-based dashboards with metrics and charts that highlight critical information around the day-to-day activities of project team members including controllers, managers, buyers, procurement team members, requesters, and sourcing experts. This in-depth, multidimensional analysis of transactional data means that you can take corrective actions to resolve issues proactively. You can drill down directly from a dashboard to associated pages in Oracle Projects, Oracle Purchasing, and other related Oracle E-Business Suite applications for immediate access to the underlying processes.

Project Procurement Command Center Dashboards for Roles

The Project Procurement Command Center provides dashboards for the following roles. The dashboards are organized by role under the following responsibilities and menus:

Role Dashboard Responsibility, Menu
Project manager, project controller, project team member Procurement Plan Projects Super User, Projects: Delivery
Project buyer, procurement team member Project Procurement, Oracle Purchasing User's Guide Project Procurement ECC (Buyer), Project Procurement
Project requester, buyer Item Analysis Project Procurement ECC (Buyer), Command Center, Item Analysis

Note: This dashboard is available to project managers from the Analyze Item link in the Plan Lines tab of the Procurement Plan dashboard.

Sourcing expert Supplier Analysis Project Procurement ECC (Buyer), Command Center, Supplier Analysis

Note: This dashboard is available to project managers from the Analyze Supplier link in the Plan Lines tab of the Procurement Plan dashboard.

A buyer's view and a project manager's view of a procurement plan are very similar to ensure that they have access to the same data throughout the lifecycle of the project. The manager's dashboard shows data in the context of a single project, whereas the buyer can review data across projects.

See the following topics for more information:

Important: You can use the Project Procurement Command Center only after the installation and common configurations are completed as described in My Oracle Support Knowledge Document 2495053.1, Installing Oracle Enterprise Command Center Framework, Release 12.2. For additional ECC overview information, see Overview of Oracle Enterprise Command Centers, Oracle E-Business Suite User's Guide

Searching in and Refining Enterprise Command Center Dashboards

Use the sidebar to search for and refine (filter) the data on a dashboard. You can select a value or record from the Available Refinements component, or you can use the Search field to find a keyword, a value, or a specific record. When you submit a search, or select an available refinement, the search term or refinement is added to the Selected Refinements list, and all of the dashboard data is refined. You can add multiple refinements and remove any of them at any time. Use Saved Search to create and save your search. You can edit, delete, or refer to this saved search. You can also use data sets to further refine your search.

Use an asterisk (*) or a percent sign (%) to perform a partial keyword or record search that matches any string of zero or more characters. You can also use a question mark (?) to perform a partial search that matches any single character.

Additional Information: For more information about searching for and refining data in enterprise command centers, see Search in Highlights of an Enterprise Command Center, Oracle E-Business Suite User's Guide.

Project Procurement Command Center for Project Managers

Project Procurement Command Center for Project Managers Overview

See Project Procurement Command Center Overview.

As a project manager or a project controller, use the command center to:

To access the Procurement Plan dashboard for a project, start on the Search Projects page. Search for a project and access the dashboard for that project using the following navigation:

Projects: Delivery > Search Projects page > Advanced Search > Go > Project Name link > Procurement tab

To access a project, you can use the Project List page and also you can search for a project using the project name or the project number.

The Procurement tab contains the Procurement Plan dashboard, where you can access the following:

See Procurement Plan Dashboard.

Procurement Plan Dashboard

See Project Procurement Command Center for Project Managers Overview.

As a project manager, use the Procurement Plan dashboard to plan work schedules, manage cost, and track progress for your project. The dashboard shows data in the context of a single project.

Use the dashboard to:

Access the Procurement Plan dashboard using the following navigation:

Projects Super User responsibility > Projects: Delivery > Search Projects page > Advanced Search > Go > search results > Project Name link > Procurement tab

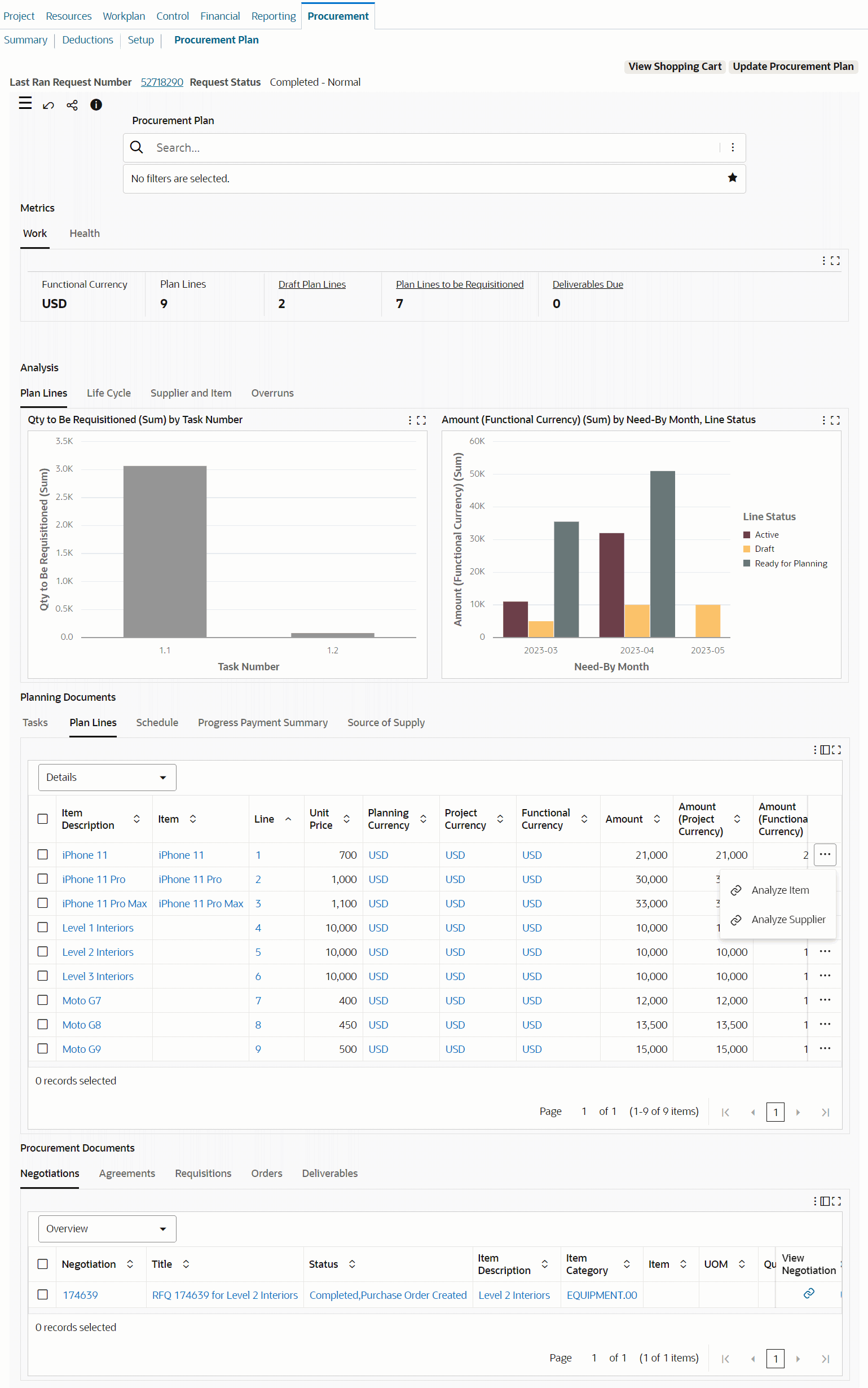

Procurement Plan Dashboard

the picture is described in the document text

The following table describes the dashboard.

Component Description
View Shopping Cart (button) Use this action to initiate requisitions using the shopping cart in Oracle iProcurement.
Update Procurement Plan (button) See Updating a Project Procurement Plan for further information.
Work (summary bar) This summary bar shows currency information and several metrics. To refine dashboard data, including the metrics, by currency, click Currencies and then select a value.
  • Plan Lines: This metric shows the number of plan lines in the current view.

  • Draft Plan Lines: This metric shows the number of draft plan lines that have a need-by date in the next 90 days.

  • Plan Lines to be Requisitioned: This metric shows the number of plan lines that must be requisitioned in the next 30 days.

  • Deliverables Due: This metric shows the number of deliverables that are due or overdue in the next 30 days.

Health (summary bar) This bar contains the following metrics:
  • Budgeted Cost: This metric shows the cost that is budgeted for this project.

  • Planned Procurement Cost: This metric shows the cost that is planned for procurement.

  • Actual Procurement Cost: This metric shows the actual supplier cost incurred on procurement for this project.

  • Procurement Progress Percentage: This metric shows the actual procurement cost, expressed as a percentage of the planned procurement cost.

  • Potential Shipment Delays: This metric shows the open shipments that have need-by dates in the next 30 days.

  • Potential Requisition Delays: This metric shows the open requisitions that are past order-by date.

Analysis (tabbed component):
Plan Lines (tab)
This tab shows the following charts. These charts display data only if the data set has a single functional currency.
  • Qty to be Requisitioned (Sum) by Task Number: By default, this bar chart shows the quantity to be requisitioned for a project by task number. Select a different dimension to view the quantity by item category, cost code, need-by month, or item description. The metrics are quantity to be ordered and quantity to be received.

  • Amount (Functional Currency) (Sum) by Need-By Month, Line Status: This chart shows the planned amount for plan lines by need-by month for each line status or an item description. The group dimensions are task number, item description, and cost code. The metrics are quantity and count of plan lines.

Analysis (tabbed component):
Life Cycle (tab)
This tab shows the following charts. These charts display data only if the data set has a single functional currency.
  • Quantity (Sum), Requested Quantity (Sum), Ordered Quantity (Sum), Received Quantity (Sum), Billed Quantity (Sum) by Task Number: By default, this bar chart shows the quantity that is planned, requested, ordered, received, and billed by task number. Select a different dimension to view the quantities by item category, need-by month, cost code, or item description.

  • Amount (Functional Currency) (Sum), Requested Amount (Sum), Ordered Amount (Sum), Received Amount (Sum), Invoiced Amount (Sum), Paid Amount (Sum) by Task Number: By default, this bar chart shows the amount that is planned, requested, ordered, received, invoiced, and paid by task number. Select a different dimension to view the amounts by item category, need-by month, cost code, or item description.

Analysis (tabbed component):
Supplier and Item (tab)
This tab shows the following charts. These charts display data only if the data set has a single functional currency.
  • Supplier Performance: This bubble chart shows performance for a supplier or an item description by quality rating and on-time delivery rating. Select an X-axis or a Y-axis metric to view the supplier performance by quality rating, price compliance, item review rating, supplier review rating, or score. The bubble size represents the total spend.

  • Product Variety: By default, this bar chart shows the ordered items for a project by count of items and task number. Select a different dimension to view the ordered items by cost code, or item description.

Analysis (tabbed component):
Overruns (tab)
This tab shows the following charts. These charts display data only if the data set has a single functional currency.
  • Actual Over Planned: By default, this bar chart shows the difference between the quantity ordered and the quantity planned by need-by month only for those cases where the actual quantity is more than the planned quantity. Select a different group dimension to view the quantity by task number, or cost code. The metrics are ordered amount, unit price, and invoice amount.

  • Unplanned Orders: This bar chart shows the ordered amount or ordered quantity for unplanned orders by approval year. The unplanned orders are the orders that are placed for a specific project and task, but were not planned using plan lines. Select a different dimension to view the amount or quantity by approval month, task number, or cost code. If the objective is to reduce unplanned spend, then you can monitor that on a daily basis using this chart.

Planning Documents (tabbed component)
Tasks (results table)
This table shows the details for the project tasks.
Planning Documents (tabbed component)
Plan Lines (results table)
This table shows an overview of plan lines and details such as the source information and technical specification.
To perform the following actions, click the row-level Actions icon and select an action.
  • To analyze and replace an item for a plan line, select Analyze Item to open the Item Analysis dashboard. The application carries the context of the procurement plan line to the dashboard and shows the line details. You can compare and replace an item or service using the Compare with Procurement Lines action. You can replace an item or a service only when the plan line is in the Draft status and with another item or service in the same purchasing category. See Item Analysis Dashboard.

  • To compare and analyze the supplier performance for an item or service for a plan line, select Analyze Supplier to open the Supplier Analysis dashboard. The application filters the suppliers based on the item or the service, or the description and the item category and displays suppliers who have supplied the item or the service on the procurement plan line. See Supplier Analysis Dashboard.

Planning Documents (tabbed component)
Schedule (results table)
This table shows the schedule of item quantities in the procurement plan for the lines in the Plan Lines tab.
Planning Documents (tabbed component)
Progress Payment Summary (results table)
This table summarizes the payment progress for plan lines and details for pay items.
Planning Documents (tabbed component)
Source of Supply (results table)
This table shows the sources of supply that are authorized by the buyer for the plan lines.
Procurement Documents (tabbed component)
Negotiations
Agreements
Requisitions
Orders
Deliverables
(results tables)
These tables shows the purchasing documents associated with the plan lines that are displayed in the Planning Documents tab.
You can perform the following row-level actions:
  • Negotiations, Agreements, Requisitions, and Orders tables

    • To review a document and act on it based on the document status, click the link icon in the View column.

  • Orders table

    • If an order is for complex services, then click the link icon in the Create Work Confirmation column to navigate to the Create Work Confirmation page in Oracle Purchasing and complete the work order.

  • Deliverables table

    • To update a deliverable, click the link icon in the Manage Deliverable column to open the deliverable page in Oracle Purchasing.

Options (table-level actions) See Performing Actions for information about these actions.

Performing Actions

The following sections describe the actions that you can perform from the Options icon in the results tables.

Common Actions

The following are the common actions that are available from the Options icon in the results tables.

Plan Lines Tab Actions

the picture is described in the document text

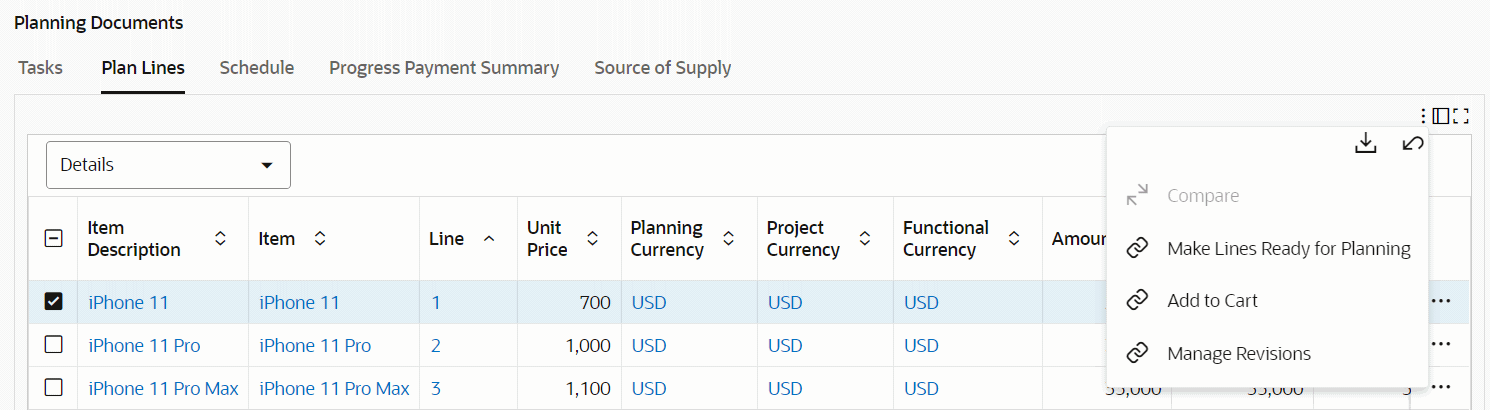

Schedule Tab Actions

the picture is described in the document text

The following table describes the actions available when you select the Options icon in the results tables. Select one or more rows and click the Options icon to act on your selection.

Results Table Action Description
Plan Lines Make Lines Ready for Planning Use this action to authorize the project buyer to start sourcing the items or services required for the project by marking the applicable plan lines as ready for planning. This authorization changes the plan line status from Draft to Ready for Planning. To perform this action, the plan lines must be in the Draft status. If the action is successful, then a confirmation message appears and the application automatically updates the records to display real-time data on the dashboard. The Line Status column shows the Ready for Planning status, which helps the project buyer to review the plan lines and set the status to Active. Then, you can add the eligible lines to the shopping cart.
Plan Lines Add to Cart Use this action to add eligible lines to the shopping cart and create purchase requisitions for service-based lines.
Before you add to the cart, the project buyer must perform the "Update Procurement Plan Lines" action and the line status must be Active. See Updating Plan Lines, Oracle Purchasing User's Guide.
When you select lines and click this action, the Shopping Cart page opens in Oracle iProcurement. Select Checkout in the Shopping Cart page and add the details for the requisition and submit. See Checkout, Oracle iProcurement User Guide for information about creating requisitions.
Plan Lines Manage Revisions Use this action to view the changes to the plan lines across different revisions. When you select one or more lines and click this action, the Revision History for Procurement Plan Line page appears. See Reviewing History for Plan Lines, Oracle Purchasing User's Guide.
Schedule Add to Cart Use this action to add eligible lines to the shopping cart and create purchase requisitions for goods-based lines. You can add lines that are at the Active status with pending quantity (more than zero).
Before you add to the cart, the project buyer must perform the Update Procurement Plan Lines action and the line status must be Active. See Updating Plan Lines, Oracle Purchasing User's Guide.
When you select lines and this action, the Shopping Cart page appears in Oracle iProcurement. Select Checkout in the Shopping Cart page and add the details for the requisition and submit. See Checkout, Oracle iProcurement User Guide for information about creating requisitions.
After you add to the shopping cart, if the action is successful, then a confirmation message appears and the application automatically updates the records to display real-time data on the dashboard. The Requested Quantity, On-Cart Quantity, and Pending Quantity columns show the updated values when you add lines to the shopping cart or remove lines from the shopping cart.

Creating a Project Procurement Plan

See Procurement Plan Dashboard.

As a project manager, you can create a procurement plan and specify a periodic delivery schedule for the items and services associated to the plan lines using the Create Procurement Plan page.

To create a procurement plan:

  1. Access the Create Procurement Plan page using the following navigation:

    (N) Projects Super User responsibility > Projects: Delivery > Search Projects

  2. Search and locate a project for which you want to create a procurement plan.

  3. Select the applicable project and click the Procurement link to open the Procurement Plan page.

    For projects that do not contain procurement plans, the Procurement Plan page shows the Create Procurement Plan button.

  4. Click Create Procurement Plan to open the Create Procurement Plan page for the selected project.

  5. Click Download to download a template, along with any existing plan lines, in XML format. Using Microsoft Excel to open the XML file as a spreadsheet.

  6. Enter or update data as required.

    Important: The spreadsheet enables you to work with the procurement plan for a single project. The Microsoft Excel spreadsheet has three worksheets: Plan Lines, Schedules, and Progress Summary. Refer to the Using Spreadsheets to Create and Update Procurement Plans topic for details about the steps in using the spreadsheet.

  7. Save changes in the same file format (XML).

  8. Click Browse and select the saved file.

  9. Click Upload.

You can create or update procurement plans using interface tables. See Using Interface Tables to Create and Update Procurement Plans, Oracle Projects Implementation Guide.

Using Spreadsheets to Create and Update Procurement Plans

See the following topics for more information:

Overview

This topic contains instructions about using the spreadsheet to work with your procurement plan.

Use the spreadsheet to:

You can create plan lines with a status of Draft or Ready for Planning. Note that you cannot update the status of a plan line that is Draft to Ready for Planning. If plan lines are created as draft lines, the only way to update the status is from the Procurement Plan dashboard.

Prerequisites and Considerations

Before you begin working with the spreadsheet, consider the following:

  1. The spreadsheet is downloaded as XML, and you must save and upload it in XML format. If you use the Save As option, then ensure that you do not change the file format, change only the file name.

  2. The spreadsheet enables you to work with the procurement plan for a single project.

  3. Do not reorder the columns in the spreadsheet.

  4. The Microsoft Excel spreadsheet has three worksheets: Plan Lines, Schedules, and Progress Summary. All three sheets must be used in conjunction with each other to define the procurement plan.

  5. Do not use the spreadsheet to delete procurement plan lines in the application. To cancel using a plan line for goods, set all schedules to zero. If no downstream document exists for the plan line, then the line will no longer appear in the Procurement Plan page.

  6. When you update an existing procurement plan line that has a status other than Draft, the application enables you to update certain columns. The application validates only those columns that are updatable, and discards any changes made to columns that are not eligible for update.

  7. You must enter each requirement as a separate row in the spreadsheet.

  8. Data entered into the spreadsheet is case-sensitive. The application is not designed to validate and accept data entered in the incorrect case.

  9. You must enter data within the column range specified in the spreadsheet. When you insert or populate a new row, ensure that all required attributes are populated with valid values. The application attempts to parse all data (including white spaces) entered in a new row or in a column outside the specified column range. Data entered outside the column range could lead to unexpected errors during processing, which can be difficult to troubleshoot.

  10. Any number of users can download the procurement plan using this method. However, multiple users cannot make changes to the procurement plans of the same project simultaneously. When a user successfully uploads their procurement plan, the application blocks any updates to the same procurement plan, if the spreadsheet was downloaded before the recent most spreadsheet upload.

    For example, User 1 and User 2 each download the procurement plan spreadsheet for Project A. Both users make changes to the Procurement Plan. User 1 uploads the procurement plan back into the application. When User 2 tries to upload the procurement plan, the application will not process the spreadsheet. This is to ensure that users do not overwrite each other's work.

How to Use the Spreadsheet

To perform the spreadsheet upload process:

  1. When you click Download for a project that does not contain a Procurement Plan, Oracle Projects downloads an XML spreadsheet template. If you click Download for a project with a procurement plan, the XML spreadsheet displays all the existing plan lines, schedules, and the progress summary.

  2. Save the XML spreadsheet document to a local folder. If you use Microsoft Windows and Microsoft Office Excel, double-clicking the file opens the spreadsheet in Microsoft Office Excel. If that does not work, or if the file opens in a different application, you can associate a file type using the following:

    Right-click the extracted XML file and select the option Open With > Choose Program > Microsoft Office Excel.

  3. In the spreadsheet, insert new information or update existing details for lines, schedules, and progress summary. Read this section for information about how each field in the spreadsheet is validated.

  4. Click the Save or Save As option to save the spreadsheet in the same format. If the application prompts you, opt to save the spreadsheet in XML.

  5. Click Browse, select the file that you saved in your local drive, and then click Upload.

The Upload Process and Error Handling

When you upload the procurement plan, the application automatically runs the Procurement Plan Import concurrent program. Success or failure is clearly indicated on the Procurement Plan page. The program attempts to process all lines entered in the spreadsheet. If any line has a validation error, the process is completely rolled back, and the application displays the entire set of error messages which indicate what the problem is. Use the instructions provided in the spreadsheet to correct the data and re-upload the sheet.

Note that due to the architecture of the XML Parsing program, the application does not individually validate for certain errors. For example: Line Type is NULL, alpha-numeric characters entered in planning rate field, and so on. For errors like these, the concurrent program fails with a generic error message indicating that the worksheet has invalid data. Verify that all required fields are populated, and that there are no character values in a numeric field and then retry the upload.

Entering or Updating Worksheets

The following sections describe how to enter or update the Plan Lines, Schedules, and Progress Summary worksheets in the downloaded spreadsheet.

Entering or Updating the Plan Lines Worksheet

A procurement plan consists of many plan lines. Each plan line is for a specific item or service to be procured for the project. When you need to procure an item or service for a project, use the spreadsheet to create a new line in the procurement plan. When you create a new line, you need to specify certain information such as item number or description, planning rate, UOM, currency, expenditure type, and so on. These values are used in downstream procurement documents at a later time.

The following table describes each column in the Plan Lines worksheet and its corresponding field in the application, including descriptions, rules, and validations.

Field Name Description Validations Rules for Create Plan Line Rules for Update Plan Line
Line Number A unique number (primary key) for each plan line within a project. Track multiple period requirements or progress summary to the plan line using the plan line number. Required field. Enter a number. Enter a number that does not exist in the system, or in the spreadsheet, to create a new plan line. Enter the plan line that needs to be updated.
Line Type The line type that is used in the purchase order when this line is purchased. Required field. Only line types with a value basis of Quantity, Amount, or Fixed Price are valid. Value basis of rate is not currently supported. Enter a valid line type: quantity, amount, or fixed price. You can change the line type only when the plan line has a draft status.
Version Number The current version number of the plan line Read-only field The version number is 0 (numeric zero) when the plan line has a Draft status. The version number will be incremented only when the plan line does not have Draft status. You cannot update the version number.
Category The concatenated segments of the purchasing category. For example: HARDWARE.KEYBOARD. Required if the item number is not specified Enter any valid purchasing category. For plan lines with item numbers, you can update the category only when the plan line has a status of Draft. For plan lines without item number, you can update the category any time.
Item Number The item or inventory item (in Item Master) to be procured Valid for line types with a value basis of Quantity only. Item number should not be populated if the line type has a value basis of amount or fixed price.
Any valid purchasable item available in the item master, and enabled in the Inventory Organization of the operating unit, as specified in Financial Options (Use a Purchasing responsibility > Setup > Organizations > Financial Options). Either item number, or category, and description are required.
Enter a valid Item Number. You can update the Item Number only when the plan line has a draft status.
Item Description The one-time item or service description Maxiumum 240 characters in length. Enter a description if no item number is specified. If you have entered the item number, the description you enter will be disregarded, because the description is defaulted from the item master. Enter a description. You can update the description any time.
Destination The final destination of the item or service Optional field
Valid values for destination type are Expense and Inventory
Enter a destination. You can update the destination only when the plan line has a Draft status.
Status The status of the plan line Read-only A new plan line is always created with a status of Draft. You cannot update the status.
Buyer The buyer to which the plan line is assigned Optional field.
The value must correspond to a name in Human Resources (FULL_NAME in PER_ALL_PEOPLE_F). If the value of the profile option PO: Enforce Project Security is Yes, then a valid buyer who is also a key member of the project must be specified. If the value of the profile option is No, then any valid buyer may be specified.
Enter the full name of the buyer. Update the buyer name on a plan line any time.
Parent Line The line number of a plan line that parent of the current plan line Optional field. Number. NA Enter a number that exists in the application in the Active status. You can update the parent line only when the plan line has a draft status.
Suggested Supplier The project manager recommends this supplier to the buyer for procuring the plan line item or service. Optional field.
Enter either an existing supplier name (that matches with a supplier name in the supplier master), or a new supplier who doesn't exist in the system. If the entered supplier matches with a supplier in the supplier master, the ID of this supplier is stored. Otherwise, the entered supplier is considered a new supplier suggested by the project manager.
Enter the name of a supplier. You can update the suggested supplier value at any time.
Acquisition Strategy Primary Objective Specify the primary objective while selecting the supplier for this plan line. Optional field.
Acceptable values are available in the lookup PA_PSC_SUPP_SELECTION
Enter a valid value. You can update the acquisition strategy primary objective any time.
Acquisition Strategy Secondary Objective Specify the secondary objective while selecting the supplier for this plan line. Optional field.
Acceptable values are available in the lookup PA_PSC_SUPP_SELECTION
Enter a valid value. You can update the acquisition strategy secondary Objective any time.
Source System Name Enter the source system name to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system name any time.
Source System Document Number Enter the source system document number to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system document number any time.
Source System Document Version Enter the source system document version to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system document version any time.
Source System Line Number Enter the source system line number to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system line number any time.
Source System Line Version Enter the source system line version to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system line version any time.
Source System Date Enter the source system date to identify which source system the requirement came from. This is to synchronize with third-party Engineering models or any other third-party system. Optional field. 240 characters. NA You can update the source system date any time.
Additional Information Enter any additional information or specifications relevant to the plan line. Optional field. 2000 characters. NA You can update the additional information any time.
Expenditure Type Each project has a list of expenditure types. Project managers track how much spend takes place for each expenditure type in a plan line. Required field. Any valid expenditure type with expenditure type class as Supplier Invoice. Enter a valid expenditure type. You can update the expenditure type any time.
Planning Currency The currency code for the item to be procured as entered in the plan. Required field. If the currency is not specified then the functional currency of the operating unit will be considered as Planning currency. If the specified currency is different from the functional currency of the Operating Unit or the Project's Primary Currency, the currency conversion rate has to be specified in the Financial Forecast in the Project Procurement Setup. The system derives a valid exchange rate on the first day of each month for the entire duration of the project. Enter a valid currency code. You can update the planning currency when the plan line has a draft status only.
Planning Rate The per-unit rate in the planning currency, at which you plan to procure the item/service for this project.
For line-types with value-basis Amount, planning rate will be overwritten and defaulted to 1.
Required field. Any positive decimal, that is rounded to the extended currency precision. Enter a valid planning rate for the plan line. You can update the planning rate any time.
Planning Amount Calculated from planning rate and overall planned quantity Read-only field NA NA
Committed Amount The amount of this line requisitioned Read-only field NA NA
Obligated Amount The amount of this line on a purchase order Read-only field NA NA
Received Amount The total amount received for the purchase order Read-only field NA NA
Invoiced Amount The total amount invoiced for the purchase order. Read-only field NA NA
Retained Amount The total amount withheld from payment for the plan line Read-only field NA NA
Paid Amount The total amount paid for the invoices created for the plan line Read-only field NA NA
UOM The Unit of Measure for the item to be procured Conditionally required field. UOM is required for Plan lines with line types with value basis Quantity or Amount. UOM is not mandatory for plan lines with value basis of Fixed Price.
UOM field is not mandatory when Inventory Item Number is entered. If left blank, the Primary UOM of the Inventory Item Number is used.
Enter a valid UOM. You can enter a UOM for one-time items any time.
Quantity Planned The total quantity on the plan line (sum of requirements) Read-only field NA NA
Quantity Requested The total quantity on a purchase requisition Read-only field NA NA
Quantity Ordered Total quantity on a purchase order Read-only field NA NA
Quantity Received The total quantity received for a purchase order Read-only field NA NA
Quantity Rejected Total quantity rejected during quality inspection Read-only field NA NA
Quantity Overdue The total quantity that is yet to be received on shipments that are beyond the promised date of the plan line. Read-only field NA NA
Next Shipment Date The next expected shipment for plan lines that have due or overdue shipments. Read-only field NA NA
Attribute Category Descriptive Flexfield Attribute Category. Optional NA NA
ATTRIBUTE1 Plan Line Attribute Descriptive Flexfield 1 Optional NA NA
ATTRIBUTE2 Plan Line Attribute Descriptive Flexfield 2 Optional NA NA
ATTRIBUTE3 Plan Line Attribute Descriptive Flexfield 3 Optional NA NA
ATTRIBUTE4 Plan Line Attribute Descriptive Flexfield 4 Optional NA NA
ATTRIBUTE5 Plan Line Attribute Descriptive Flexfield 5 Optional NA NA
ATTRIBUTE6 Plan Line Attribute Descriptive Flexfield 6 Optional NA NA
ATTRIBUTE7 Plan Line Attribute Descriptive Flexfield 7 Optional NA NA
ATTRIBUTE8 Plan Line Attribute Descriptive Flexfield 8 Optional NA NA
ATTRIBUTE9 Plan Line Attribute Descriptive Flexfield 9 Optional NA NA
ATTRIBUTE10 Plan Line Attribute Descriptive Flexfield 10 Optional NA NA
ATTRIBUTE11 Plan Line Attribute Descriptive Flexfield 11 Optional NA NA
ATTRIBUTE12 Plan Line Attribute Descriptive Flexfield 12 Optional NA NA
ATTRIBUTE13 Plan Line Attribute Descriptive Flexfield 13 Optional NA NA
ATTRIBUTE14 Plan Line Attribute Descriptive Flexfield 14 Optional NA NA
ATTRIBUTE15 Plan Line Attribute Descriptive Flexfield 15. Optional NA NA
ATTRIBUTE16 Plan Line Attribute Descriptive Flexfield 16 Optional NA NA
ATTRIBUTE17 Plan Line Attribute Descriptive Flexfield 17 Optional NA NA
ATTRIBUTE18 Plan Line Attribute Descriptive Flexfield 18 Optional NA NA
ATTRIBUTE19 Plan Line Attribute Descriptive Flexfield 19 Optional NA NA
ATTRIBUTE20 Plan Line Attribute Descriptive Flexfield 20 Optional NA NA

Entering or Updating the Schedules Worksheet

A specific item might be required on a project during multiple time-periods, while performing multiple tasks, and need to be delivered to multiple locations. To do this, specify the quantity of the item required for each delivery date and location for the project duration for a task, or for a combination of task and delivery-location.

The following table describes each column in the Schedules worksheet and its corresponding field in the application, including descriptions, rules, and validations.

Field Name Description Validations Rules for Create Plan Line Rules for Update Plan Line
Schedule Number A number by which the schedule is identified. Unique within a plan-line and is the primary key for the schedule line. Required field; number. Enter a schedule number that does not exist in the system, or in the sheet, for the plan line. Enter the schedule number to update.
Line Number The line number to which requirements are specified. Required field. Enter a plan line number that exists in the spreadsheet, or in the system. Update a plan line number that exists in the spreadsheet, or in the system.
Line Type The line type on the associated plan line, for reference during updates Read-only field NA NA
Category The category on the associated plan line, for reference during updates Read-only field NA NA
Item Number The item number on the associated plan line, for reference during updates. Read-only field NA NA
Description The description on the associated plan line, for reference during updates. Read-only field NA NA
Task Number Used to identify the task for which the material is procured.
Filter by task to check what material was ordered, and received; helps the project manager decide if the task can be started or not.
Required field. Any valid task number on the project. Task number is a text column and if the task has any numeric value, the column should be formatted manually using a single quote. Enter a valid Task Number. You can update the Task Number any time.
Location The deliver-to location for the item Optional field. Enter a valid deliver-to location for the operating unit of the project. Enter a valid deliver-to location. You can update the deliver-to location any time.
Requester Name Name of the requester Required NA NA
Need-By-Date The need-by date for the item to be procured Required NA NA
Quantity The quantity of each item (or amount for an amount based line) required. Enter the need by date for the quantity. Required field. Non-negative decimal number. Enter a quantity and also a need- by date. Enter zero if the item is not required. You can update the requirement any time.
UOM The Unit of Measure for the items to be procured Read-only field NA NA
Period Name Month and year in which the item is to be procured Read-only field NA NA
Period Start Date The start date from which the item is to be procured Read-only field NA NA
Period End Date The end date by which the item is to be procured Read-only field NA NA
Attribute Category Schedules Descriptive Flexfield Category Optional NA NA
ATTRIBUTE1 Schedules Descriptive Flexfield 1 Optional NA NA
ATTRIBUTE2 Schedules Descriptive Flexfield 2 Optional NA NA
ATTRIBUTE3 Schedules Descriptive Flexfield 3 Optional NA NA
ATTRIBUTE4 Schedules Descriptive Flexfield 4 Optional NA NA
ATTRIBUTE5 Schedules Descriptive Flexfield 5 Optional NA NA
ATTRIBUTE6 Schedules Descriptive Flexfield 6 Optional NA NA
ATTRIBUTE7 Schedules Descriptive Flexfield 7 Optional NA NA
ATTRIBUTE8 Schedules Descriptive Flexfield 8 Optional NA NA
ATTRIBUTE9 Schedules Descriptive Flexfield 9 Optional NA NA
ATTRIBUTE10 Schedules Descriptive Flexfield 10 Optional NA NA
ATTRIBUTE11 Schedules Descriptive Flexfield 11 Optional NA NA
ATTRIBUTE12 Schedules Descriptive Flexfield 12 Optional NA NA
ATTRIBUTE13 Schedules Descriptive Flexfield 13 Optional NA NA
ATTRIBUTE14 Schedules Descriptive Flexfield 14 Optional NA NA
ATTRIBUTE15 Schedules Descriptive Flexfield 15 Optional NA NA
ATTRIBUTE16 Schedules Descriptive Flexfield 16 Optional NA NA
ATTRIBUTE17 Schedules Descriptive Flexfield 17 Optional NA NA
ATTRIBUTE18 Schedules Descriptive Flexfield 18 Optional NA NA
ATTRIBUTE19 Schedules Descriptive Flexfield 19 Optional NA NA
ATTRIBUTE20 Schedules Descriptive Flexfield 20 Optional NA NA

Entering or Updating the Progress Summary Worksheet

A project may require complex services, for which payment is based on the progress of work. Using the Progress Summary, specify the different type of pay items and the payment to be released, based on the progress of work during the project duration for a task.

The following table describes each column in the Progress Summary worksheet and its corresponding field in the application, including descriptions, rules, and validations.

Field Name Description Validations Rules for Create Plan Line Rules for Update Plan Line
Pay Item Number A number by which the pay item is identified. Unique within a plan-line and is the primary key for the Pay item line. Required field; number. Enter a pay item number that does not exist for the plan line in the application, or in the sheet. Enter the pay item number to update.
Line Number The line number for the specified pay items. Required field Enter a plan line number that exists either in the sheet, or in the application. Update a plan line number that exists either in the sheet, or in the application
Pay Item Type The pay item type can be Milestone, Rate and Lumpsum.
Plan lines having line type with value basis as Quantity can have Milestone pay items only. Plan lines having line type with value basis as Fixed Price can have all the three types of pay items.
Required field Enter a valid pay item type. You can update the pay item type only if the plan line has a status Draft.
Pay Item Description Describes the pay item Required field NA You can update the pay item description any time.
Task Number Used to identify the task for which the service is procured.
Filter by task to check what material was ordered, and received; helps the project manager decide if the task can be started or not.
Required field. Any valid task number on the project. Task Number is a text column and if the task number contains any numeric value, the column should be formatted manually with single quotes. Enter a valid task number. You can update the task number any time.
Quantity The quantity to be used for the Rate pay item type Conditionally required field Enter the quantity. You can update the quantity any time.
UOM The Unit of Measure for the service to be procured Conditionally required field. UOM is required only for the Rate pay item type. Enter a valid UOM. You can update the UOM any time.
Value (%) The percentage of payment made for the plan line Conditionally required field. Value (%) is required for the Milestone pay item type. Enter the Value (%). You can update the Value (%) any time.
Price The unit rate in the planning currency, at which you plan to procure the service for the project. Required field. Any positive decimal. Rounded to the currency precision. Enter a valid price for the plan line. You can update the price any time.
Amount Calculated from the Quantity, Price, and Value (%). Read-only field NA NA
Need-By Date The date by when the service is to be delivered. Required field. Enter a current or future date. Enter a need-by date for the pay item. You can update the need-by date any time.
PO Number The purchase order created for the plan lines and pay items. Read-only field NA NA
Quantity/Amount Ordered The total quantity or amount ordered on a purchase order for the pay item Read-only field NA NA
Quantity/Amount Received The total quantity or amount received on a purchase order against the pay item Read-only field NA NA
Quantity/Amount Billed The total quantity or amount billed for a purchase order against the pay item Read-only field NA NA
Quantity/Amount Cancelled The total quantity or amount canceled for a purchase order against the pay item Read-only field NA NA
Attribute Category Schedule Progress Descriptive Flexfield Category Optional NA NA
ATTRIBUTE1 Schedule Progress Descriptive Flexfield 1 Optional NA NA
ATTRIBUTE2 Schedule Progress Descriptive Flexfield 2 Optional NA NA
ATTRIBUTE3 Schedule Progress Descriptive Flexfield 3 Optional NA NA
ATTRIBUTE4 Schedule Progress Descriptive Flexfield 4 Optional NA NA
ATTRIBUTE5 Schedule Progress Descriptive Flexfield 5 Optional NA NA
ATTRIBUTE6 Schedule Progress Descriptive Flexfield 6 Optional NA NA
ATTRIBUTE7 Schedule Progress Descriptive Flexfield 7 Optional NA NA
ATTRIBUTE8 Schedule Progress Descriptive Flexfield 8 Optional NA NA
ATTRIBUTE9 Schedule Progress Descriptive Flexfield 9 Optional NA NA
ATTRIBUTE10 Schedule Progress Descriptive Flexfield 10 Optional NA NA
ATTRIBUTE11 Schedule Progress Descriptive Flexfield 11 Optional NA NA
ATTRIBUTE12 Schedule Progress Descriptive Flexfield 12 Optional NA NA
ATTRIBUTE13 Schedule Progress Descriptive Flexfield 13 Optional NA NA
ATTRIBUTE14 Schedule Progress Descriptive Flexfield 14 Optional NA NA
ATTRIBUTE15 Schedule Progress Descriptive Flexfield 15 Optional NA NA
ATTRIBUTE16 Schedule Progress Descriptive Flexfield 16 Optional NA NA
ATTRIBUTE17 Schedule Progress Descriptive Flexfield 17 Optional NA NA
ATTRIBUTE18 Schedule Progress Descriptive Flexfield 18 Optional NA NA
ATTRIBUTE19 Schedule Progress Descriptive Flexfield 19 Optional NA NA
ATTRIBUTE20 Schedule Progress Descriptive Flexfield 20 Optional NA NA

Updating a Project Procurement Plan

See the following topics for more information:

Use the Update Procurement Plan page to update a project procurement plan. You can modify content and add new lines to a procurement plan by downloading the existing procurement plan and uploading it after making changes to it.

To update a project procurement plan:

  1. In the Project Search page, click Advanced Search. From the search results, click the Project Name link to select a project, and then open the Procurement tab.

  2. For projects that already have an existing procurement plans, the Procurement Plan page shows the Update Procurement Plan button.

  3. Click Update Procurement Plan to open the Update Procurement Plan page for the selected project.

  4. Click Download to download a zip file containing the procurement plan spreadsheet.

  5. Unzip the archive and extract the XML spreadsheet document in a local folder. If you use Microsoft Windows and Microsoft Office Excel, then double-click the file to open the spreadsheet in Microsoft Office Excel. If you are not able to open the file with this method, or if the file opens in a different application, then you can make a file-type association by right-clicking the extracted XML file and then clicking Open With > Choose Program > Microsoft Office Excel.

  6. Update existing lines and periodic requirements or add new lines. Once all changes are made, use Save or the Save As option to save the file in the same format. If the system prompts you, then choose to save the workbook in the same format.

Updating Procurement Plan Line Attributes

The following are the points to consider when you update a procurement plan.

  1. When you need to change any attribute of a procurement plan line, you can:

    • Freeze the current version of the line identified by the procurement plan, procurement plan line number, and procurement plan line version number.

    • Create a new record for the same procurement plan, procurement plan line number, and procurement plan but with the next higher line version number.

  2. To keep a procurement plan line version in sync with the corresponding source of demand, you can modify any of the following attributes of the line:

    • Category of the procurement plan line

    • Item description

    • Destination

    • Buyer name

    • Suggested supplier

    • Acquisition strategy primary objective

    • Acquisition strategy secondary objective

    • Source information reference (All source related details)

    • Additional information

    • Expenditure type

    • Planning rate

    • Purchasing UOM

    • For one or more of the schedules for a material line:

      • Task Number

      • UOM

      • Location

      • Quantity

    • For one or more of the pay items for a services line:

      • Pay item type

      • Pay item description

      • Task number

      • Quantity

      • UOM

      • Value(%)

      • Price

      • Need-by date

    • You can also add any of the following:

      • One or more schedules for a material line

      • One or more pay items for a services line

      • Suggested suppliers

      • A reference to a document detailing one or more components of the technical specifications

      • A reference to a document detailing the submittal requirements

  3. You can change procurement plan lines irrespective of the status of the plan line. You can not, however, make manual updates to the status of the plan line. The version number column in the plan lines sheet is a read-only field. If you provide a value for the version number, then the application will ignore it during data upload. The version number is automatically updated to 0 when a plan line is uploaded in the Draft status. Any changes to the plan lines in draft status will not increment the version number. The version number is incremented by 1 when any of the plan lines that are not in Draft status are changed or updated. For example, if a plan line is in the Ready for Planning status, and the attributes of the plan line are changed, then the application automatically increments the version number by 1. Incrementing the version number by 1 puts the plan line in the Revised status.

    Scenario Application Behavior
    Updates to Plan lines that are in Draft status No change in application behavior
    Updates to plan lines that are in the Ready for Planning status When the plan line is in Ready for Planning status and the changed attribute falls under one of the following attributes:
    • Category of the procurement plan line

    • Item description: you can update only for descriptive items

    • Technical Specification URL

    • Buyer name

    • Suggested supplier

    • Acquisition strategy primary objective

    • Acquisition strategy secondary objective

    • Source information reference (All source related details)

    • Additional Information

    • Expenditure type

    • Planning rate

    • Purchasing UOM

    • For one or more of the schedules for a material line:

      • Task Number

      • Need-by date

      • Location

      • Quantity

    • For one or more of the pay items for a services line:

      • Pay item type

      • Pay item description

      • Task number

      • Quantity

      • UOM

      • Value(%)

      • Price

      • Need-by date

      or if you add:

    • One or more schedules for a material line

    • One or more pay items for a services line


    then,
    • The status of the plan line displays Revised.

    • The number of plan lines that are in Revised status is displayed as a metric in both the Procurement Plan and Project Procurement dashboards.

    Updates to plan lines that are in the Active status When the plan line is in the Active status and the changed attribute falls under one of the below attributes:
    • Category of the procurement plan line

    • Item description: you can update only for descriptive items

    • Technical Specification URL

    • Buyer name

    • Suggested supplier

    • Acquisition strategy primary objective

    • Acquisition strategy secondary objective

    • Source information reference (All source related details)

    • Additional Information

    • Expenditure type

    • Planning rate

    • Purchasing UOM

    • For one or more of the schedules for a material line:

      • Task Number

      • Need-by date

      • Location

      • Quantity

    • For one or more of the pay items for a services line:

      • Pay item type

      • Pay item description

      • Task number

      • Quantity

      • UOM

      • Value(%)

      • Price

      • Need-by date

      or if you add:

    • One or more schedules for a material line

    • One or more pay items for a services line


    then,
    • The status of the plan line displays Revised.

    • The number of plan lines that are in Revised status is displayed as a metric in both the Procurement Plan and Project Procurement dashboards.

  4. To upload the spreadsheet, go to the Update Procurement Plan page for the selected project, click Browse, select the file that was just saved, and click Upload.

Note: You can create or update procurement plans using interface tables. See Using Interface Tables to Create and Update Procurement Plans, Oracle Projects Implementation Guide.

Analyzing Items and Suppliers

Item Analysis Dashboard

The Item Analysis dashboard is centered upon items that have been ordered for procurement.

The Item Analysis dashboard is available from the following command centers:

The following table lists the command centers, responsibilities, and the roles to which the dashboard is available.

Command Center Role Responsibility Additional Information
Project Procurement Command Center Project buyer, project manager Project Procurement ECC (Buyer), Command Center

Note: This dashboard is available to project managers from the Analyze Item link in the Plan Lines tab of the Procurement Plan dashboard. The dashboard shows the item information in the context of a procurement plan line.

Analyze items or services assigned to project plan lines
Procurement Command Center, Oracle Purchasing User's Guide Procurement team member, buyer Purchasing, Procurement Command Center

Note: This dashboard is also available from the Analyze Item link in the Requisitions tab of the Procurement Operations dashboard. The dashboard shows the item information in the context of a requisition line.

Analyze items or services assigned to requisition lines

Use the dashboard to:

Note: The dashboard data is always refined to the organizations to which the user has access, and to transactions that match the selected currency.

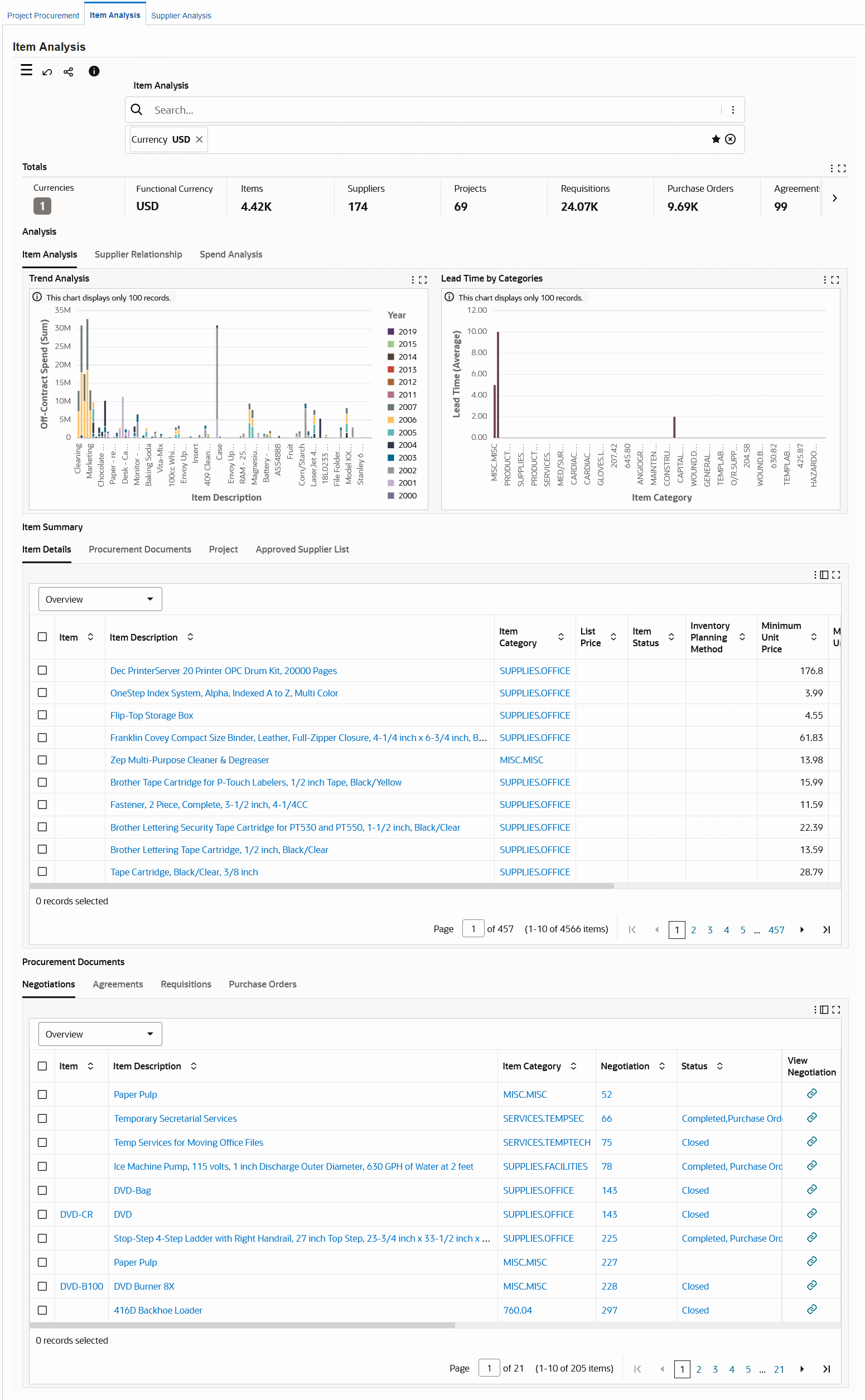

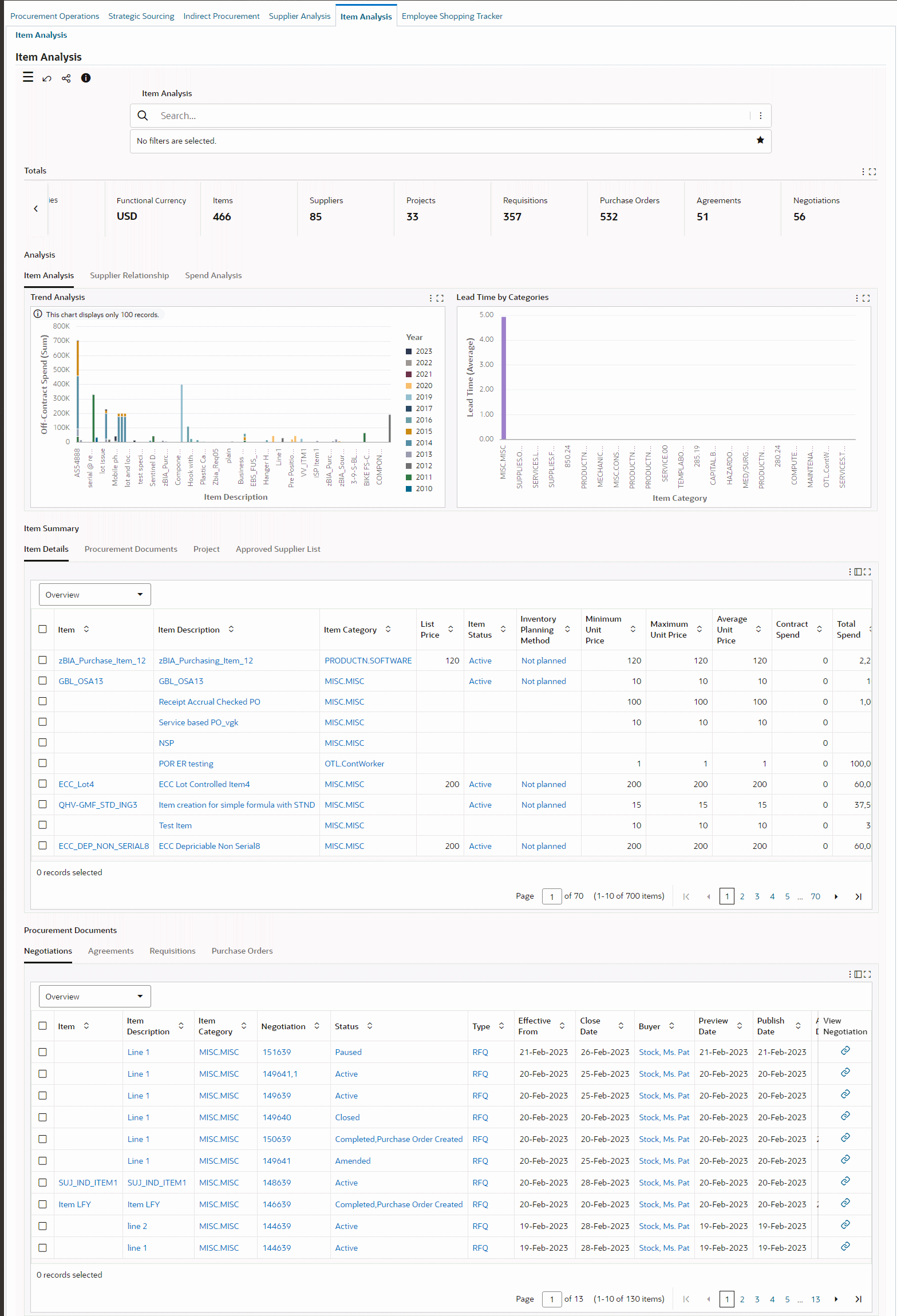

Procurement Command Center: Item Analysis Dashboard

the picture is described in the document text

Project Procurement Command Center: Item Analysis Dashboard

the picture is described in the document text

The following table describes the dashboard:

Component Description
Totals (summary bar) This summary bar displays currency information and several metrics. To refine dashboard data, including the metrics, by currency, click Currencies and then select a value.
  • Items: This metric shows the number of items represented in the current view.

  • Suppliers: This metric shows the number of suppliers who supplied items in the past.

  • Projects: This metric shows the number of projects for which items have been procured, or are being planned.

  • Requisitions: This metric shows the number of requisitions in which items are referenced.

  • Purchase Orders: This metric shows the number of purchase orders in which items are referenced.

  • Agreements: This metric shows the number of agreements in which items are referenced.

  • Negotiations: This metric shows the number of negotiations in which items are referenced.

Analysis (tabbed component)
Item Analysis (tab)
This tab contains the following charts:
  • Trend Analysis: This is a chart to analyze the total spend by item description. This chart displays data only when a single functional currency has been selected. You can sort the chart using the following values:

    • Contract spend, which is the purchase orders spend amounts that are linked to agreements.

    • Off-Contract spend, which is the purchase order spend amounts that are not linked to agreements.

  • Lead Time by Categories: This chart shows the average lead time for agreement lines by categories for item category and item.

Analysis (tabbed component)
Supplier Relationship (tab)
This tab contains the following charts:
  • Overall Supplier Performance: This is a bubble chart to analyze the overall supplier performance. Select an X-axis or a Y-axis metric to view the supplier performance by quality rating or price compliance. The bubble size shows the total spend sum. This chart displays data only when a single functional currency has been selected.

  • Supplier Performance Over Time: By default, this chart shows the performance over time for a supplier by total spend. Select a different metric to view the supplier performance by price compliance or quality rating. This chart displays data only when a single functional currency has been selected.

Analysis (tabbed component)
Spend Analysis (tab)
This tab contains the following charts:
  • Spend Spread: By default, this pie chart shows the spend spread for an item category. Select a different dimension to view the spend spread by deliver to location or supplier name. This chart displays data only when a single functional currency has been selected.

  • Off Contract Spend: This bar chart analyzes the contract spend and the off-contract spend for an item category. Contract spend is the purchase orders spend amounts. Off-Contract spend is the purchase order spend amounts that are not linked to agreements. This chart displays data only when a single functional currency has been selected.

Items Summary (tabbed component)
Item Details, Procurement Documents, Project, Approved Supplier List (results tables)
These tables summarize the details for items and information related to items in procurement documents, projects, and approved supplier lists.
Procurement Documents (tabbed component) includes:

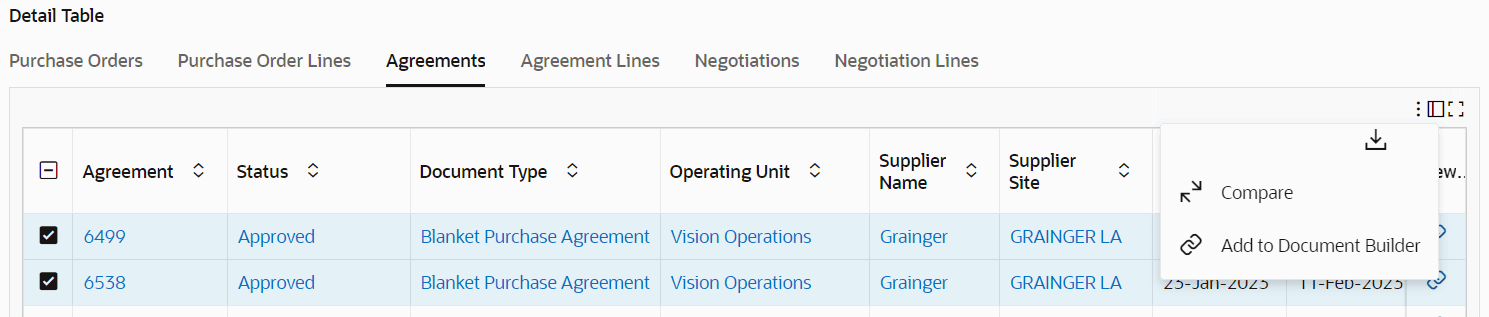

Negotiations, Agreements, Requisitions, and Purchase Orders (results tables)
These tables show details for purchasing documents associated with items. You can review information for negotiations, agreements, requisitions, and purchase orders.
From the Negotiations, Agreements, Requisitions, and Purchase Orders tables, to view details for a document or perform any action, click the link icon in the View column to navigate to the document's page.
Options (table-level actions) See Performing Actions.

Performing Actions

The following sections describe the actions that you can perform from the Options icon in the results tables.

Common Actions

The following are the common actions that are available from the Options icon in the results tables.

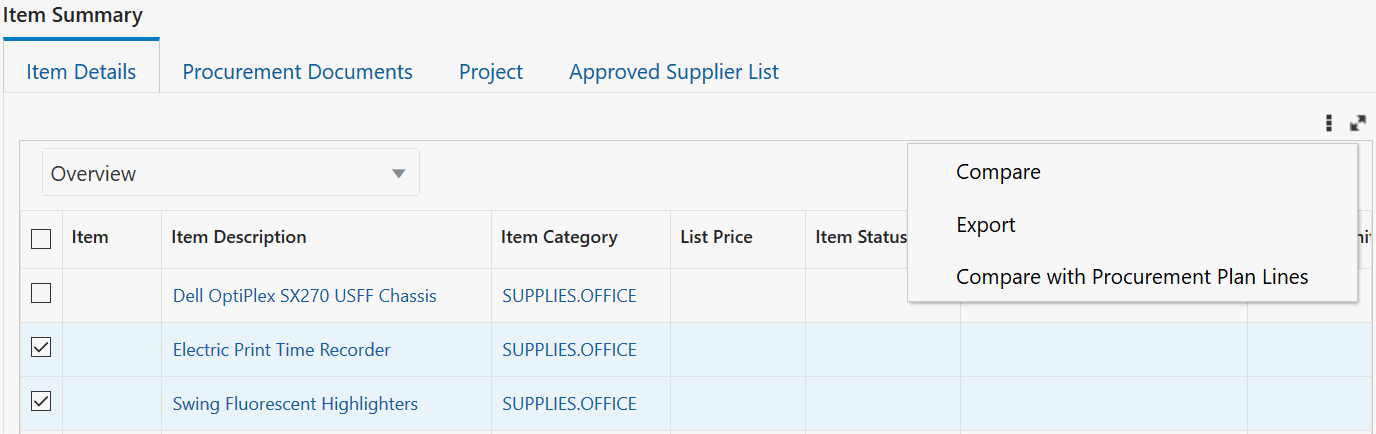

Actions for Item Details

the picture is described in the document text

Replace Item

the picture is described in the document text

The following table describes the actions available when you select the Options icon in the Item Details results table. Select one or more rows and click the Options icon to act on your selection.

Action Description
Compare with Procurement Lines This action is applicable to project managers and project buyers using the Item Analysis dashboard from the Project Procurement Command Center.
Project Buyer:
As a project buyer, use this action to compare an item with the item specified on the procurement plan. If there are no procurement plan lines, then you cannot perform this action. See Project Procurement Dashboard, Oracle Purchasing User's Guide.
Use the following navigation to the perform this action:
  1. Navigate to the Project Procurement dashboard.

  2. Scroll to the Planning Documents tabbed component.

  3. In the Plan Lines tab, click the link icon in the Analyze Item column for the plan line that you want to investigate. The Item Analysis dashboard appears.

  4. Scroll to the Item Summary tabbed component.

  5. In the Item Details tab, ensure to select the items that belong to the same item category as the item specified on the plan line. An error message appears if the item category is different.

  6. Select Compare with Procurement Lines action.

  7. Scroll to the top of the dashboard that displays both the selected item description with the item specified on the procurement plan.


Project Manager:
As a project manager, use this action to compare and replace an item or a service in the plan line. You can replace an item or a service only when the plan line is in the Draft status and with another item or service in the same purchasing category. See Procurement Plan Dashboard.
Use the following navigation to perform this action:
  1. Navigate to the Item Analysis dashboard using the following navigation: Procurement Plan dashboard for a project > Planning Documents tabbed component > Plan Lines tab > click the link icon in the Analyze Item column for a plan line. The Item Analysis dashboard provides a summary of the procurement history of the item or service, including current orders and suppliers.

  2. Search for alternative items and if you find an alternative item that works better for this project, then select the item in the Item Summary tabbed component > Item Details table and select the Compare with Procurement Lines action from the Options icon.

  3. Scroll to the top of the dashboard that displays both the selected item description with the item specified on the procurement plan.

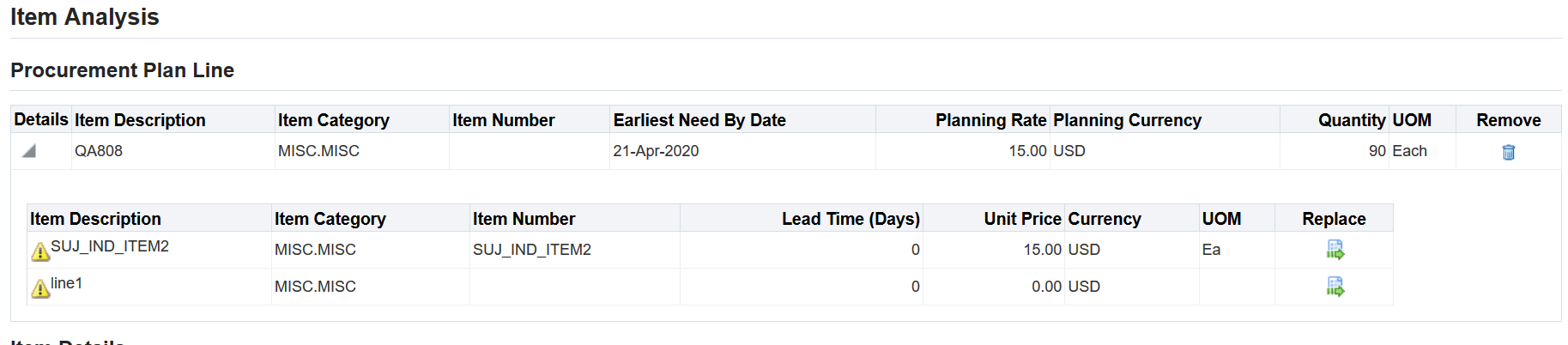

  4. To replace the item or service in the plan line, click the Replace icon.

  5. Manually change the quantity and planning rate of the replaced item or service, if required. Where there is no match (for item number, description, and category) or where the budget exceeds what is on the plan line, or where the earliest need-by-date cannot be met by the lead-time, the application displays an Alert icon to indicate the potential problem of replacing the item.


If the Replace action is successful, then the application automatically updates the record to display the latest item in the Item Summary tab.

Supplier Analysis Dashboard

To perform supplier analysis, procurement teams, and buyers require supplier history for goods or services. supplier analysis involves looking into a supplier's product and service offerings, performance including on-time delivery, quality, and supplier capabilities.

The Supplier Analysis dashboard is available from the following command centers:

The following table lists the command centers, responsibilities, and the roles to which the dashboard is available.

Command Center Role Responsibility Additional Information
Project Procurement Command Center Project buyer, project manager Project Procurement ECC (Buyer), Command Center

Note: This dashboard is available to project managers from the Analyze Supplier link in the Plan Lines tab of the Procurement Plan dashboard. The dashboard shows the item information in the context of a procurement plan line.

Analyze suppliers who can supply items or services for a project and fulfill orders for project procurement plan lines
Procurement Command Center, Oracle Purchasing User's Guide Procurement team member, buyer Purchasing, Procurement Command Center

Note: This dashboard is also available from the Analyze Supplier link in the Requisitions tab of the Procurement Operations dashboard. The dashboard shows the item information in the context of a requisition line.

Analyze suppliers who can supply items or services for requisition lines

Use the dashboard to:

Note: The dashboard data is always refined to the organizations to which the user has access, and to transactions that match the selected currency.

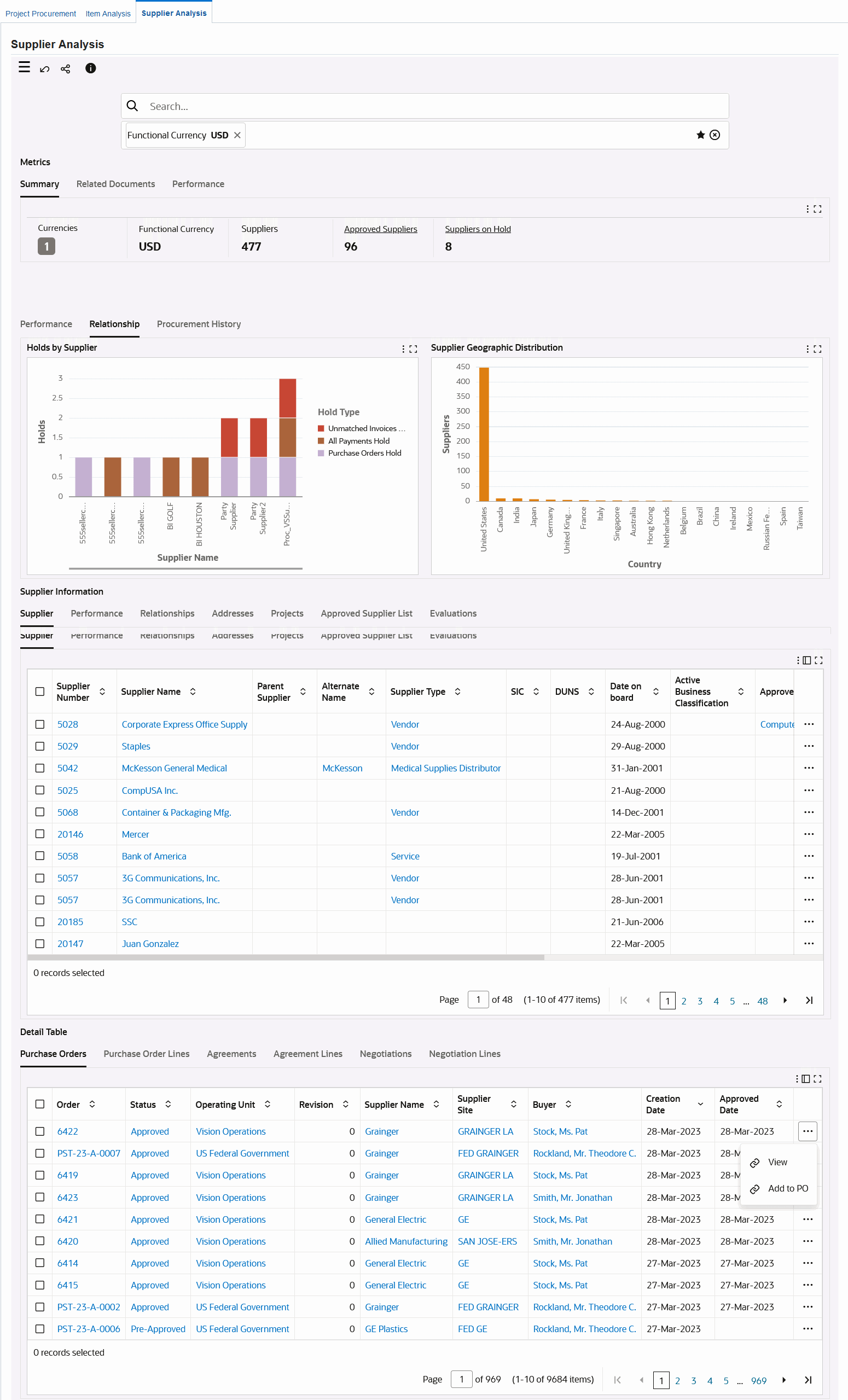

Procurement Command Center: Supplier Analysis Dashboard

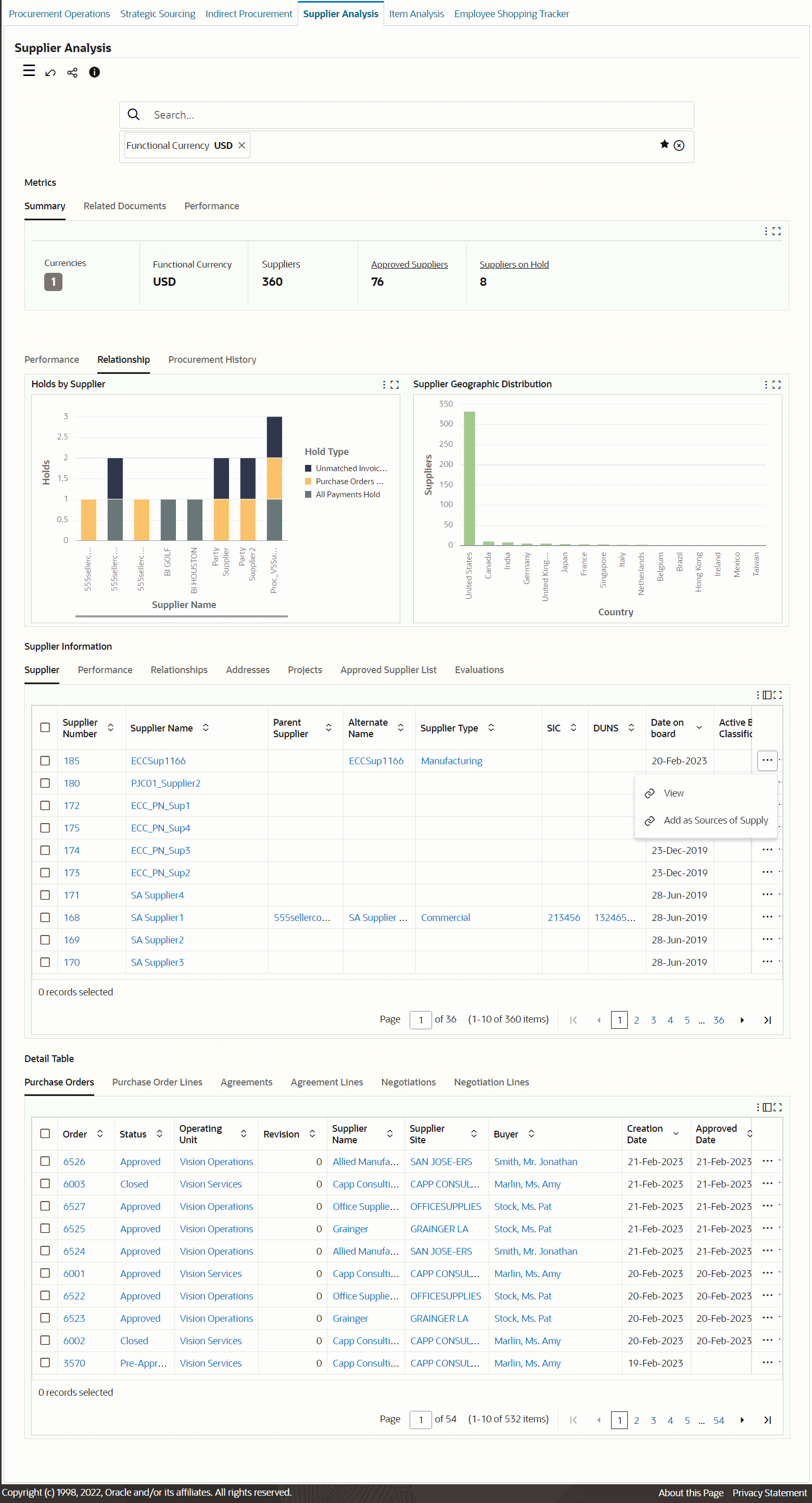

the picture is described in the document text

Project Procurement Command Center: Supplier Analysis Dashboard

the picture is described in the document text

The following table describes the dashboard:

Component Description
Summary (summary bar) This summary bar displays currency information and several metrics. To refine dashboard data, including the metrics, by currency, click Currencies and then select a value.
  • Suppliers: This metric shows the number of unique suppliers that are in the current view based on filters applied.

  • Approved Suppliers: This metric shows the number of suppliers who appear in the approved supplier list for at least one item or a category.

  • Suppliers on Hold: This metric shows the number of suppliers who have at least one active hold status, such as Hold All Payments or Hold All Purchase Orders. These suppliers have holds at the supplier level or the supplier-site level.

Related Documents (summary bar) This bar displays the following metrics:
  • Active Agreements: This metric shows the number of contract purchase agreements in the current view that are active as of today. Active agreements are those agreements that are either approved or for which reapproval is required and have not expired.

  • Orders: This metric shows the number of purchase orders in the current view.

  • Ordered Items: This metric shows the number of unique items, including description-based items, ordered from the suppliers in the current view.

  • Draft Negotiations: This metric shows the number of draft negotiations in which suppliers that are in the current view are invited to participate.

Performance (summary bar) This bar displays the following metrics:
  • On-Time Delivery: This metric shows the percentage of shipments that were received on or before the need-by date plus the tolerance.

  • Quality: This metric shows the percentage of shipments that had no quality issues.

  • Price Compliance: This metric shows the ratio of the invoiced price to the price agreed upon on the agreement or order, expressed as a percentage.

  • Item Rating: This metric shows the average review rating for catalog items, entered by requesters in iProcurement.

  • Supplier Rating: This metric shows the average review rating for suppliers, entered by requesters in iProcurement.

  • Performance Score: This metric shows the average supplier performance evaluation score for suppliers that are in the current view.

Performance (tab) This tab displays the following charts:
  • Overall Supplier Performance: By default, this bubble chart shows performance for a supplier by quality rating and on-time delivery rating. Select an X-axis or a Y-axis metric to view the supplier performance by quality rating, price compliance, item review rating, supplier review rating, or score. The bubble size represents the total spend. The chart does not display data when there are multiple functional currencies.

  • Supplier Performance Over Time: By default, this bar chart displays performance over time for a supplier by quality rating. Select a different metric to view the supplier performance by price compliance, on-time delivery rating, or performance rating. The performance evaluation score is calculated by averaging the scores for all purchase orders and agreements in the visible data set. The chart does not display data when there are multiple functional currencies.

Relationship (tab) This tab displays the following charts:
  • Holds by Supplier: This stacked bar chart shows the number of holds for a supplier by hold type.

  • Supplier's Geographic Distribution: This bar chart shows the number of suppliers by each country or supplier state.

Procurement History (tab) This tab displays the following charts:
  • Spend by Supplier: This stacked bar chart shows contract versus off-contract spend for each supplier. The chart does not display data when there are multiple functional currencies.

  • Spend Trend: This bar chart shows the total spend for each supplier by supplier performance years or item category.

Supplier Information (tabbed component)
Supplier (results table)
This table shows details for suppliers.
To perform the following actions, click the row-level Actions icon and select an action.

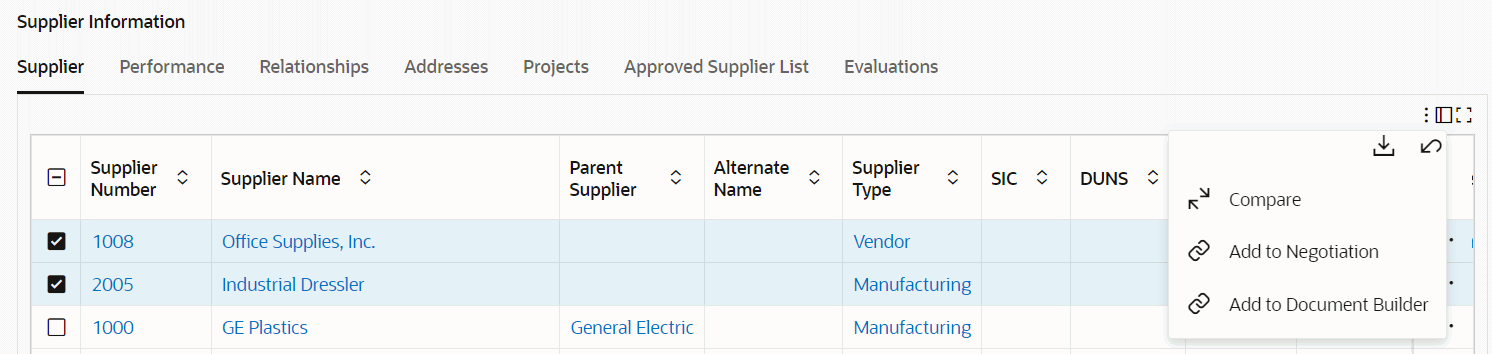

  • To update a supplier's information, select View for the supplier to navigate to the Supplier page.

  • Add as Sources of Supply: This action is applicable to buyers using Project Procurement Command Center. The first step of this action is to select Analyze Supplier for a plan line in the Project Procurement dashboard. Use this action to analyze suppliers for a plan line and then add them as sources of supply. See Project Procurement Dashboard, Oracle Purchasing User's Guide.

    To add as sources of supply:

    1. Navigate to the Project Procurement dashboard.

    2. Scroll to the Planning Documents tabbed component.

    3. In the Plan Lines tab, click the link icon in the Analyze Supplier column for a plan line. The Supplier Analysis dashboard with the plan line in context appears.

    4. Review suppliers and add them to the plan line as sources of supply.

Supplier Information (tabbed component)
Performance (results table)
This table shows the performance of suppliers including information such as the on-time delivery rating and quality rating.
Supplier Information (tabbed component)
Relationships (results table)
This table shows the active purchase orders, blanket purchase agreements, and negotiations. Additionally, it displays holds applied on active documents, total count of orders, total spend, number of negotiations in which a selected supplier participated, negotiations in which the selected supplier was awarded, average spend per year, receipt and use details.
Supplier Information (tabbed component)
Addresses (results table)
This table shows the details of suppliers.
Supplier Information (tabbed component)
Projects (results table)
This table shows the projects for which the supplier is associated to a purchasing document.
Supplier Information (tabbed component)
Approved Supplier List (results table)
This table shows the ASL approval status, the item, supplier category, and manufacturer details of approved suppliers.
Supplier Information (tabbed component)
Evaluations (results table)
To review a supplier's performance, click the link icon in the View column to open the Assessment page for that supplier.
Detail Table (tabbed component)
Purchase Orders (results table)
To perform the following actions, click the row-level Actions icon and select an action.
  • To view details for a purchase order, click View to open the purchasing document in Oracle Purchasing.

  • Add to PO: This action is applicable to buyers using the Procurement Command Center. The first step of this action is to select Analyze Supplier for a requisition line in the Requisitions dashboard. Use this action to add suppliers to purchase orders. See Requisitions Dashboard, Oracle Purchasing User's Guide.

    To add a supplier to a purchase order:

    1. Navigate to Procurement Operations > Requisitions dashboard.

    2. Scroll to the Lines tab.

    3. Click the link icon in the Analyze Supplier column for a requisition line. The Supplier Analysis dashboard with the requisition line in context appears.

    4. Review suppliers for the requisition line and then add them to the purchase order.


If you try this action without having a requisition line in context, then the dashboard displays an error. If the requisition line is valid, then you can add the requisition line to the purchase order.
Detail Table (tabbed component)
Purchase Order Lines (results table)
This table summarizes purchase order lines information and enables you to track the quantity details for orders.
Detail Table (tabbed component)
Agreements (results table)
To view details for an agreement, click the link icon in the View column to open the agreement document in Oracle Purchasing.
Detail Table (tabbed component)
Agreement Lines (results table)
The Add as Sources of Supply action is applicable to project buyers using the Project Procurement Command Center. When you click the link icon in the Add as Sources of Supply column for an agreement line, the Create Sources of Supply page appears. See Creating Sources of Supply, Oracle Purchasing User's Guide.
Detail Table (tabbed component)
Negotiations (results table)
To perform the following actions, click the row-level Actions icon and select an action.
  • To view details for a negotiation to which the suppliers have been invited, select View to open the negotiation document.

    If a negotiation is at the Closed status, view the negotiation, proceed to compare, and award the suppliers. See Awarding in Different Ways, Oracle Sourcing User Guide for information about the awarding process.

  • Add to Negotiation: This action is applicable to buyers using the Procurement Command Center. The first step of this action is to select Analyze Supplier for a requisition line in the Requisitions dashboard. Use this action to add suppliers to a negotiation. See Requisitions Dashboard, Oracle Purchasing User's Guide.

    To add a supplier to a purchase order:

    1. Navigate to Procurement Operations > Requisitions dashboard.

    2. Scroll to the Lines tab.

    3. Click the link icon in the Analyze Supplier column for a requisition line. The Supplier Analysis dashboard with the requisition line in context appears.

    4. Review suppliers for the requisition line and then add them to the purchase order.


If you try this action without having a requisition line in context, then the dashboard displays an error. If the requisition line is valid, then you can add the requisition line to the negotiation along with the supplier.
Detail Table (tabbed component)
Negotiation Lines (results table)
This table summarizes details for negotiation lines and the price information.
Options (table-level actions) See Performing Actions.

Performing Actions

The following sections describe the actions that you can perform from the Options icon in the results tables.

Common Actions

The following are the common actions that are available from the Options icon in the results tables.

The following table describes the actions available when you select the Options icon in the results tables. Select one or more rows and click the Options icon to act on your selection.

Supplier Tab Actions

the picture is described in the document text

Agreements Tab Actions

the picture is described in the document text

Agreement Lines Tab Actions

the picture is described in the document text

Results Table Action Description
Suppliers Add to Negotiation The starting point for this action is the creation of a request for quote (RFQ) in Oracle Sourcing. Create an RFQ to be able to add suppliers. For a negotiation that is at the Draft status, you can add suppliers to the negotiation from the Sourcing pages using the Add Suppliers button. This brings you to the Supplier Analysis page. Analyze the suppliers, select them, and then add them using the Add to Negotiation action.
If you delete the negotiation line after creating it through the Document Builder, then the application removes the linkage of the negotiation line as a source of supply. During the award completion stage, the application updates the sources of supply when a particular negotiation line is awarded to a supplier or multiple suppliers.
Suppliers Add to Document Builder Use this action to add suppliers to requisition lines using the Document Builder.
Agreements Add to Document Builder Use this action to add multiple agreements (contract purchase agreements and blanket purchase agreements) to the Document Builder. When you add an agreement, the action automatically brings in suppliers too.
Agreement Lines Compare with Demand This action is applicable to project buyers who are analyzing suppliers using Project Procurement Command Center. See Project Procurement Dashboard, Oracle Purchasing User's Guide.
Use this action to compare agreement lines with procurement plan lines. If plan lines are not available, then the dashboard displays an error.
The basic requirements for comparison are as follows:
  • If the plan line has an inventory item, then comparison is possible only with agreement lines of the same item.

  • If the plan line has a description-based item, then comparison is possible only with description-based agreement lines of the same category.

  • If the agreement is inactive, or if there is a problem in adding the agreement line as source of supply, then the application displays an error message.


If you do not want to retain the context of the plan line, then you can click Remove to remove the plan line context.
