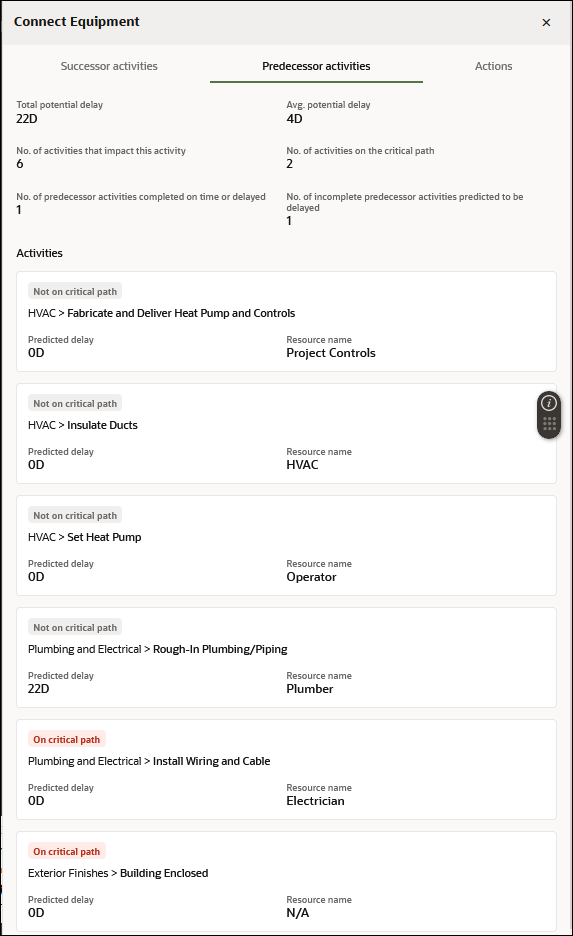

Predecessor Activities
The following information is displayed for predecessor activities when a node is selected on the activity network diagram:
- Total potential delay: The total potential delay caused by predecessor activities.
- Avg. potential delay: The average potential delay of predecessor activities.
- No. of activities that impact this activity: The number of activities that influence the activity node selected on the activity network diagram.
- No. of activities on the critical path: The total number of predecessor activities on the critical path of your project. Additional information about each critical path activity listed in the Activities section.
- No of predecessor activities completed on time or delayed: The total number of predecessor activities that have been completed on time or delayed.
- No. of incomplete predecessor activities predicted to be delayed: The total number of predecessor activities that are predicted to be delayed based on the selected activity node on the activity network diagram.
