Activity Delay Section

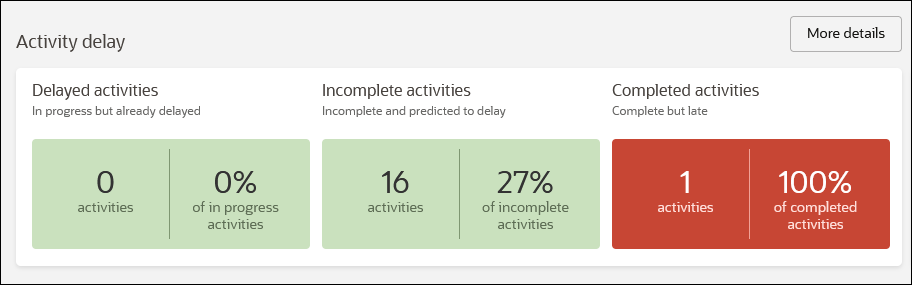

The Activity delay section provides a total count and percentages of delayed activities, incomplete activities and completed activities.
In the above example, the Haitang Corporate Park project has no delayed activities, 16 incomplete activities which represent 27% of the total activities, and 1 activity that was completed late.
The Delayed activities and Completed activities are determined by calculating the actual delay, whereas the Incomplete activities are determined calculating the predicted delay of these activities.
The delay is calculated as follows:
- For not started activities, the delay amount is calculated as:
- (Finish -BL Project Finish) if baseline exists
- (Finish -Planned Project Finish) if baseline does not exist
- For in-progress activities, the delay amount is calculated as:
- (Finish -BL Project Finish) if baseline exists
- (Finish -Planned Project Finish) If baseline does not exist, then
- For completed activities, the delay amount is calculated as:
- (Finish -BL Project Finish) if baseline exists
- (Finish -Planned Project Finish) if baseline doesn't exist
where the Project Finish is determined as follows:
- For not started activities, it is the planned finish date
- For in-progress activities, it is the remaining early finish date
- For completed activities, it is the actual finish date
Click More details to view more detailed information on the Activities Page
Related Topics
Factors Considered in Predicting Project Delay Section
