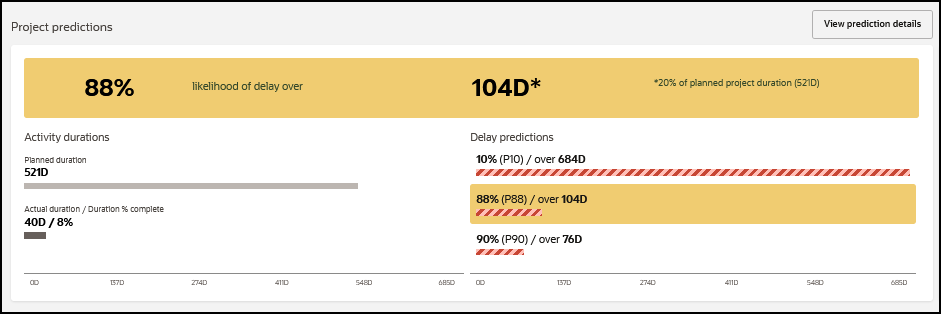

Project Predictions Section
The Project predictions section of the Schedule Intelligence page predicts the probability of delay and the extent of delay compared to the planned project duration.
The following information is displayed:
- Likelihood of delay: The Likelihood of delay predicted by the project delay models of the project being delayed by 20% of its planned duration. For example, the Haitang Corporate Park project has a 69% chance of delay for 104 days.
- Planned duration: The length of the project determined by the current project schedule. In the above example, the Planned duration is 521 days.
- Actual to date / % complete: It is calculated as 100 x (Sum (Activity Actual Duration) / Sum (Activity at Complete Duration)).
- Delay predictions: The likelihood of the project getting delayed with varying probabilities. This includes:
- Predicted duration (10% Probability): The predicted length of the project with a 10% probability of delay. The Predicted duration of the Haitang Corporate Park project with a 10% probability of delay is 522 days that includes a delay of 2 days.
- Predicted duration (60% Probability): The predicted length of the project with a 69% probability of delay. The Predicted duration of the Haitang Corporate Park project with a 69% probability of delay is 625 days which includes a delay of 104 days.
- Predicted duration (90% Probability): The predicted length of the project with a 90% probability of delay. The Predicted duration of the Haitang Corporate Park project with a 90% probability of delay is 759 days which includes a delay of 238 days.
Note: If there is no delay (zero), then the planned duration is identical to the predicted duration of the project.
Click View prediction details to access the Delay Predictions Page.
