Key Milestones Tracking Dashboard

Description: This project gives an Executive / PMO insights to track key milestones for projects/portfolios and identify variance over time. It can be used to track milestone activities based on the variance status that is ahead, on, or behind schedule. These activities can also be traced based on their activity status.

Number of Canvases: 2

Default Canvas: Key Milestones

Canvas/Dashboard Name: Key Milestones Tracking

Data Source(s): P6 EPPM

Subject Areas: P6 – Activity

Datasets: Not applicable

Canvases

Key Milestones Tracking Dashboard

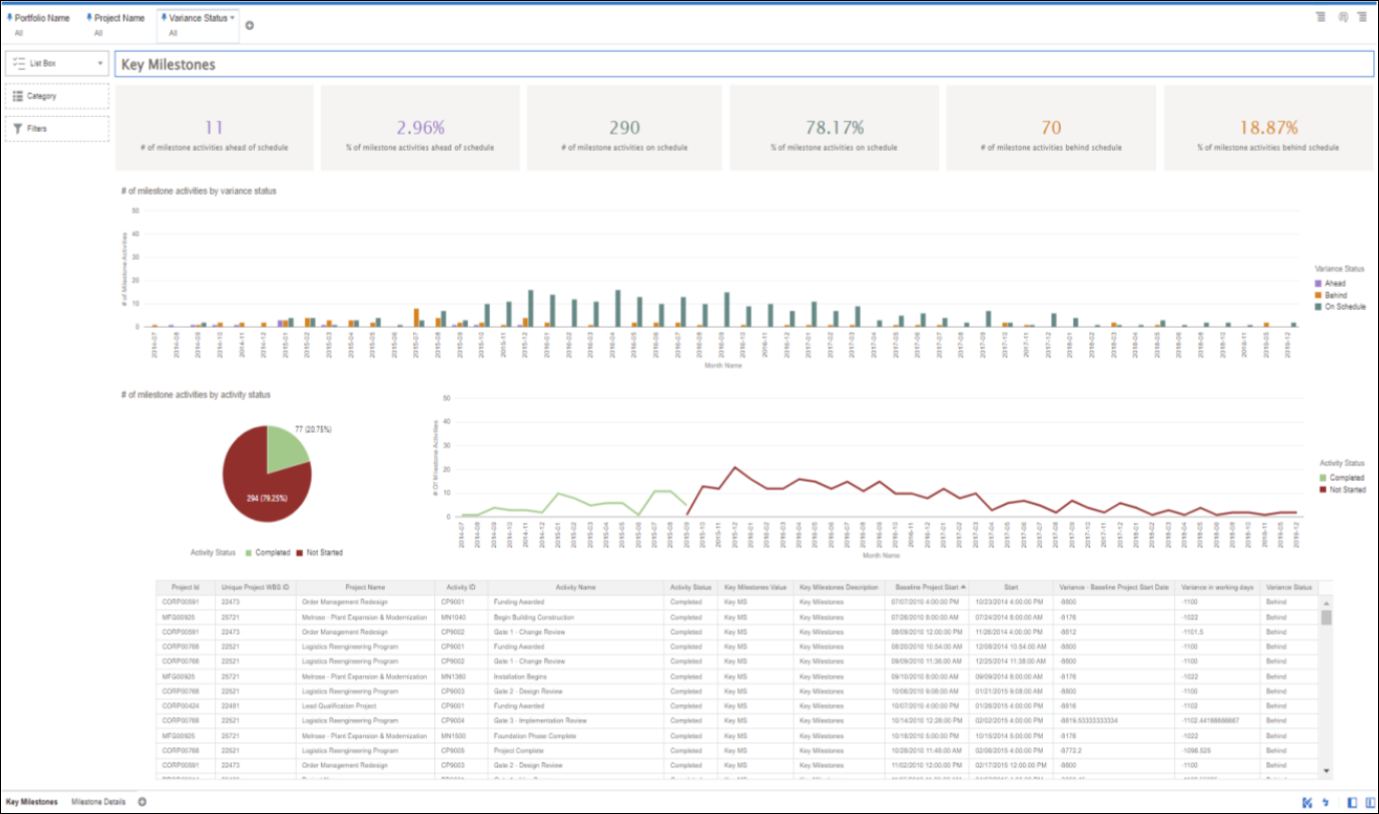

Figure 8: Key Milestones

Milestone Details of the Key Milestones Tracking Dashboard-

Figure 9: Milestone Details

Table 13: Key Milestones Tracking- Dimensions

Canvas

Dimension Name

Dimension / Attribute

Subject Area / Dataset

Key Milestones

Calendar

Month Name

P6 - Activity

Key Milestones

Activity

Activity Status

P6 - Activity

Key Milestones

Project

Project Id

P6 - Activity

Key Milestones

Project

Unique Project WBS ID

P6 - Activity

Key Milestones

Project

Project Name

P6 - Activity

Key Milestones

Activity

Activity ID

P6 - Activity

Key Milestones

Activity

Activity Name

P6 - Activity

Key Milestones

Activity

Key Milestones Value

P6 - Activity

Key Milestones

Activity

Key Milestones Description

P6 - Activity

Key Milestones

Activity

Baseline Project Start

P6 - Activity

Key Milestones

Activity

Start

P6 - Activity

Key Milestones

Activity

Variance Baseline Project Start Date

P6 - Activity

Table 14: Key Milestones Tracking- Custom Dimensions

Dimension

Expression

Source

Subject Area / Dataset

Variance in working days

"Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date"/8

Derived from Dimension

P6 - Activity

Variance Status

CASE WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 > 0 THEN 'Ahead' WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 < 0 THEN 'Behind' WHEN ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 = 0 THEN 'On Schedule' ELSE '' END

Derived from Dimension

P6 - Activity

Table 15: Key Milestones Tracking - Measures

Canvas

Fact / Measure

Measure Type

Subject Area / Dataset

Key Milestones

# of Activities

Fact

P6 - Activity

Table 16: Key Milestones Tracking - Calculated Members

Calculated Member

Expression

Source

Subject Area / Dataset

% of activities behind schedule

(FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 < 0))/"Primavera - Activity"."Metrics"."# of Activities"

Derived From Fact

P6 - Activity

% of activities on schedule

(FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 = 0))/"Primavera - Activity"."Metrics"."# of Activities"

Derived From Fact

P6 - Activity

% of activities ahead of schedule

(FILTER("Primavera - Activity"."Metrics"."# of Activities" USING ("Primavera - Activity"."Durations - (Activity)"."Variance - Baseline Project Start Date")/8 > 0))/"Primavera - Activity"."Metrics"."# of Activities"

Derived From Fact

P6 - Activity

Table 17: Key Milestones Tracking - Filters

Canvas

Filter Type

Is Expression Filter

Dimension / Attribute / Measure

Subject Area / Dataset

Key Milestones

Visualization

No

Activity Type

P6 - Activity

Key Milestones

Dashboard

No

Variance Status

P6 - Activity

Key Milestones

Dashboard

No

Project Name

P6 - Activity

Key Milestones

Dashboard

No

Portfolio Name

P6 - Activity

Table 18: Key Milestones Tracking - Data Actions

Data Action Name

Action Type

Anchor To

Target

Canvas Link

Pass Values

Multiselection

Navigate to Milestone details

Analytics Link

None

Key Milestones Tracking

Milestone Details

All

On

P6 Link to Activities

URL Navigation

Project Name

Opens P6 Links - Link to Activities

Milestone Details

All

On

Related Topics

Data Visualizations Using P6 EPPM Data

Cost Overview Dashboard

Earned Value and Risk Analysis Dashboard

Overview - Portfolio, Risk, EV

Integrated Schedule Delivery KPI Dashboard

Activity Look Ahead Dashboard

Shutdown / Turnaround / Outage Dashboard

Labor Units History Dashboard

CPI, SPI, and Labor Units Dashboard

Project Risk - Cost Overview Dashboard

Project Health Assessment Dashboard



Last Published Friday, December 8, 2023
